La Sierra Community Center - Measure G Projects
The Measure G projects have started at the La Sierra Community Center! The following are included in this phase:
- Natural Turf Soccer Field
- New sod, irrigation, and drainage system for 331,993 sf field.
- New paved walking path around soccer/project area to help increase accessibility.
- Canopy Areas Roofing
- 9,700 SF of canopy roofing, associated gutters, downspouts, and fascia replaced or repaired.
- HVAC Phases I-IV - Upgrades to systems with priority on 600 wings
- Completion Timeline - This project is expected to be completed by the end of the year. While the field project may be completed, the field area will remain closed and fenced off to allow the new natural turf adequate time to establish strong, healthy roots before regular use can resume.
Field Timeline:

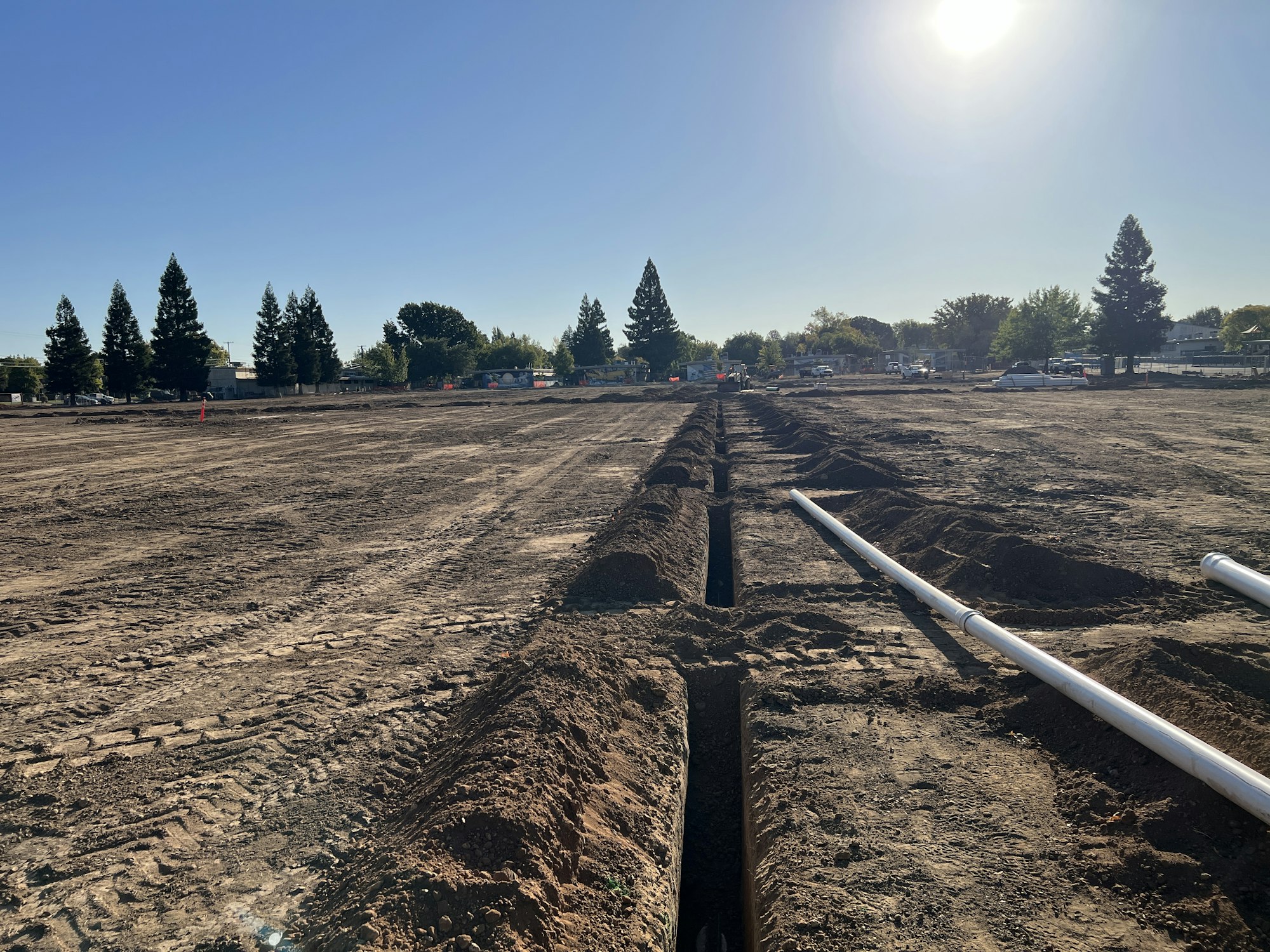

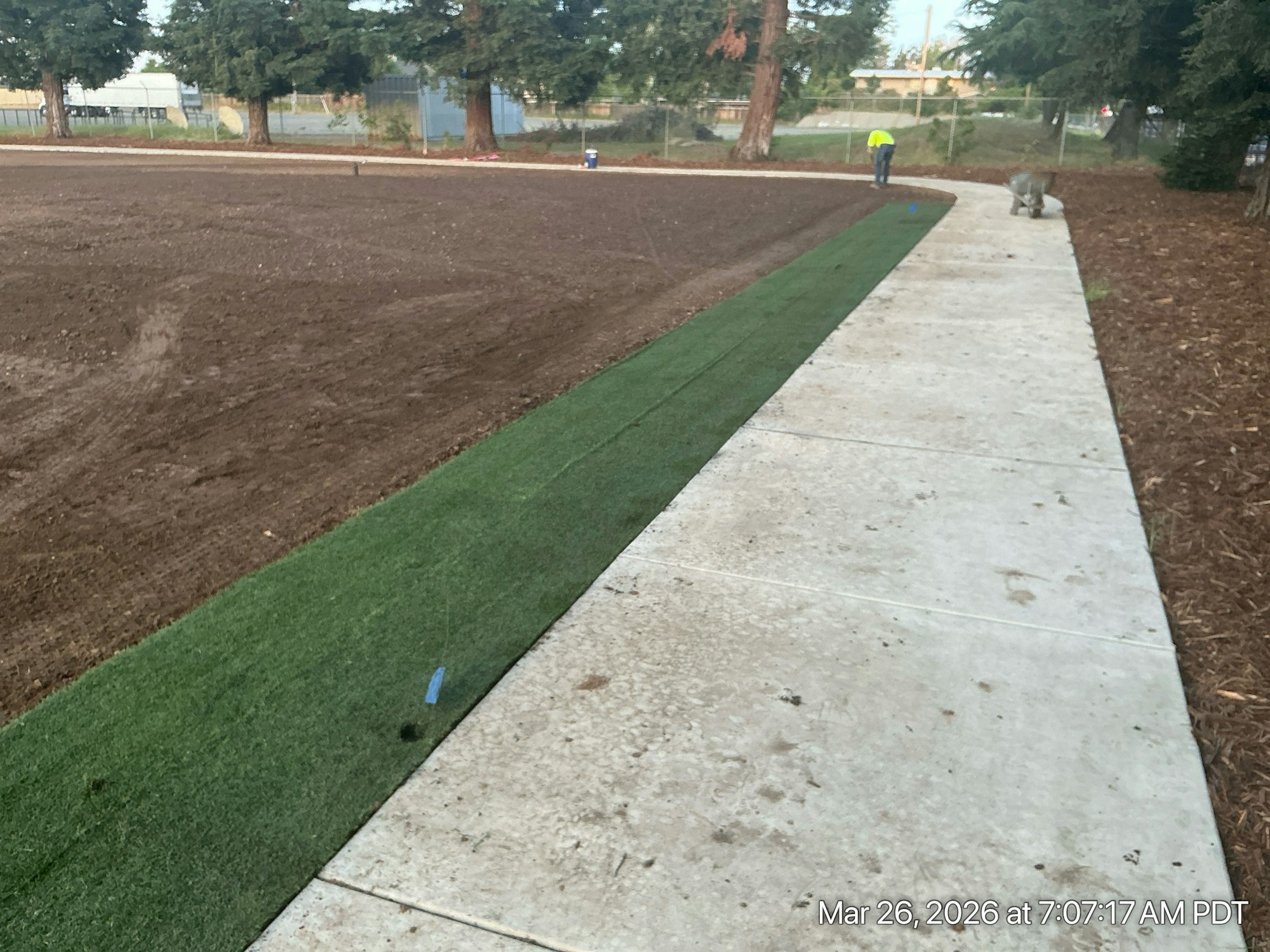

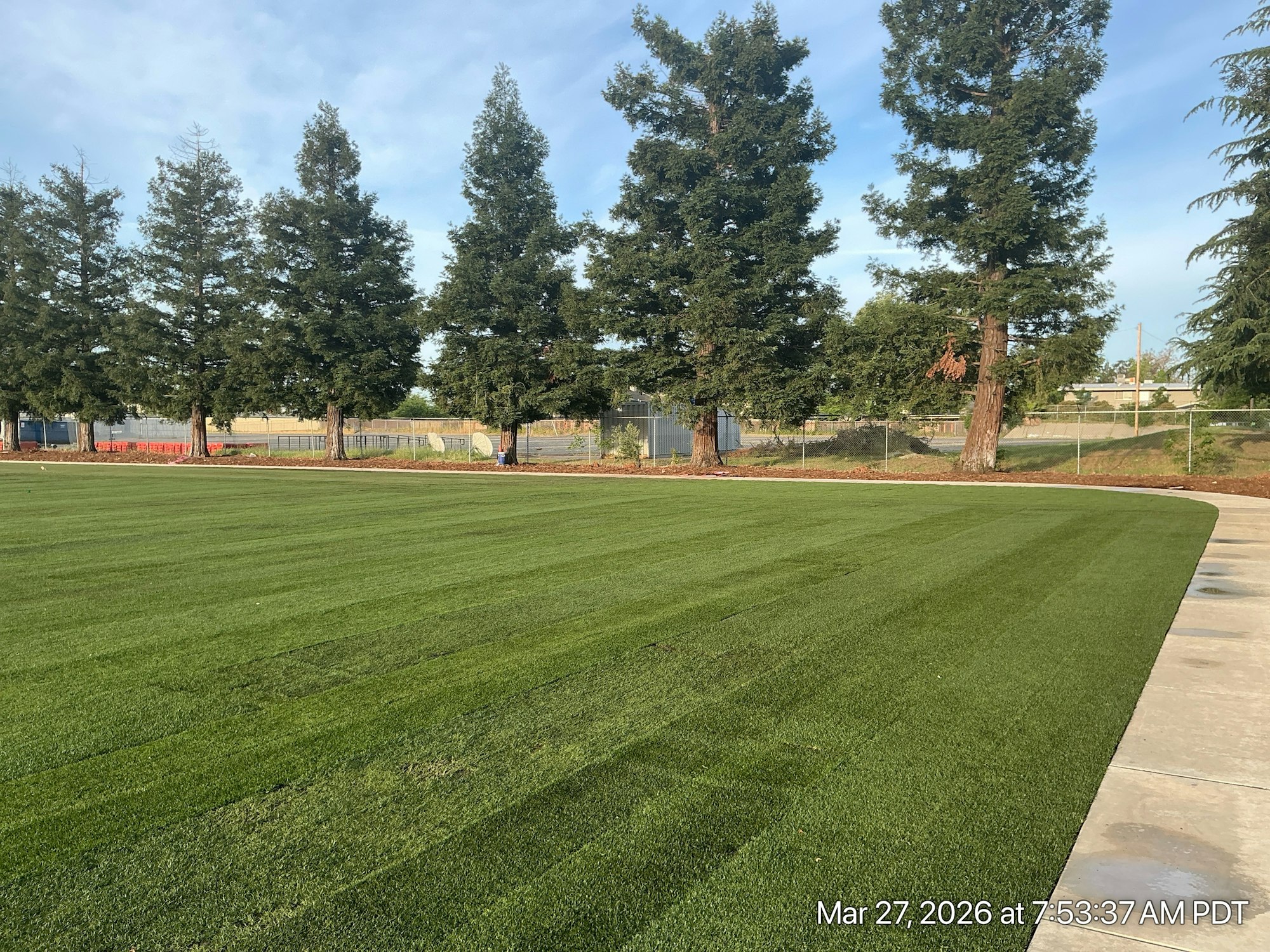

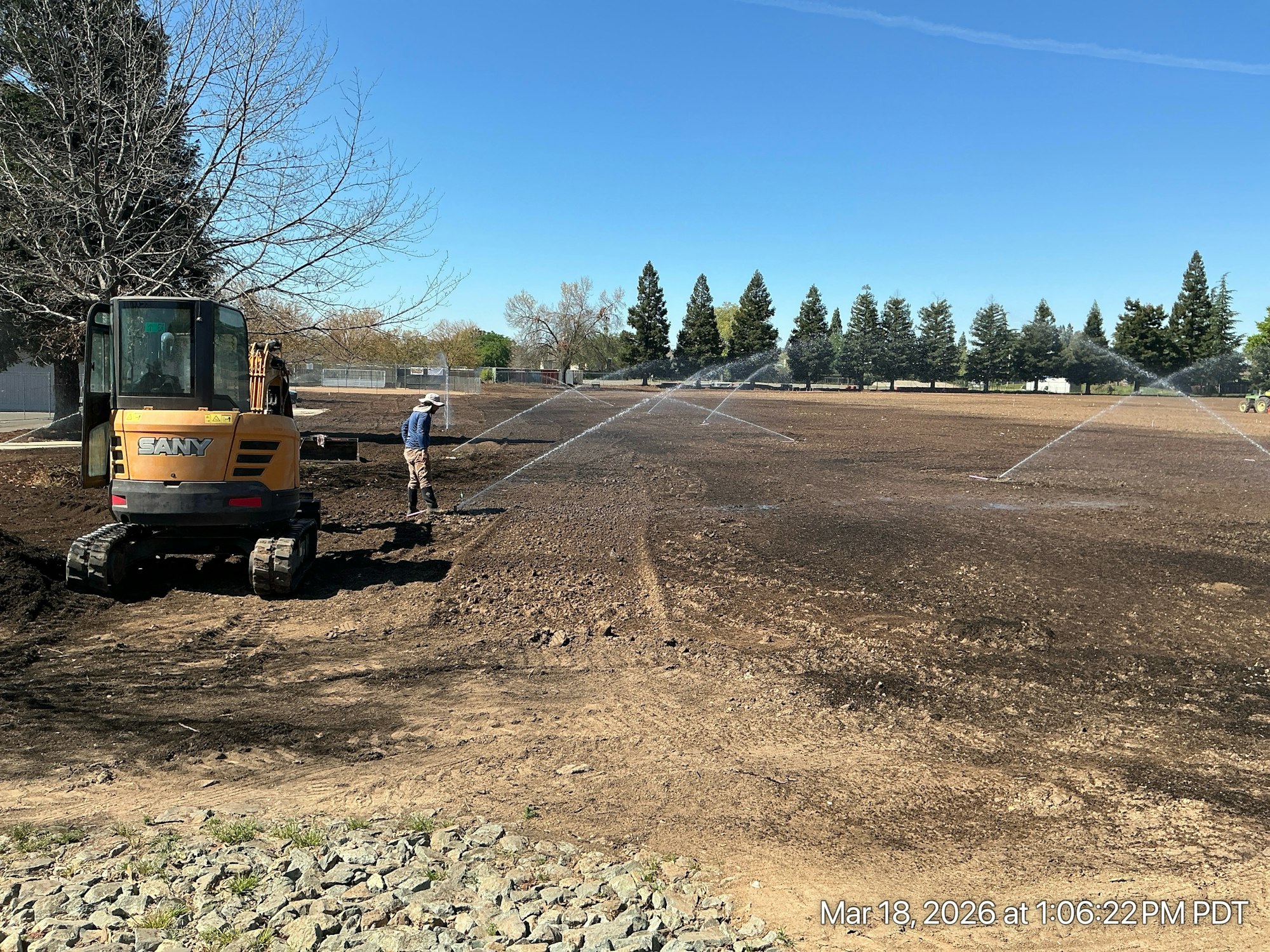

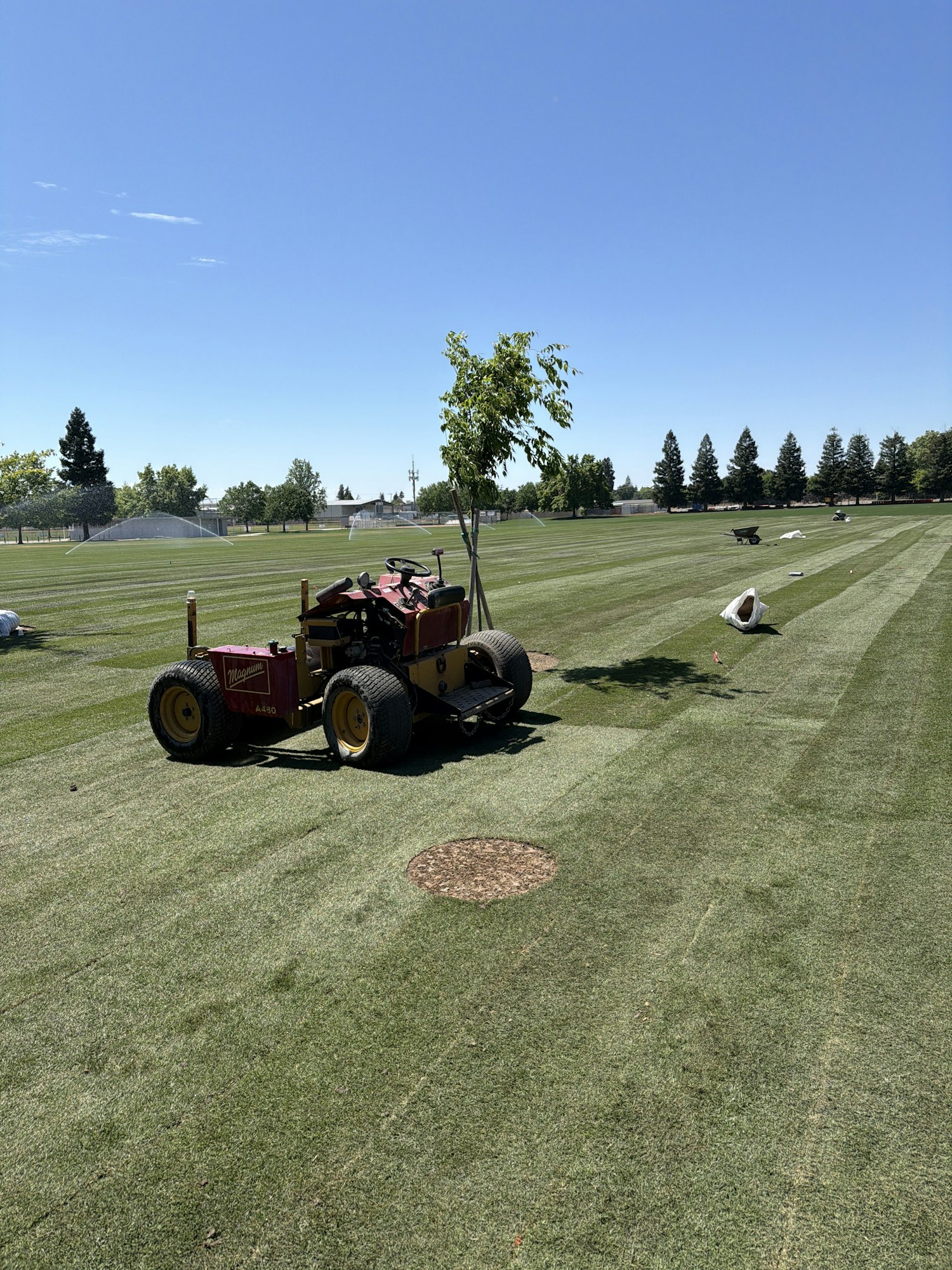

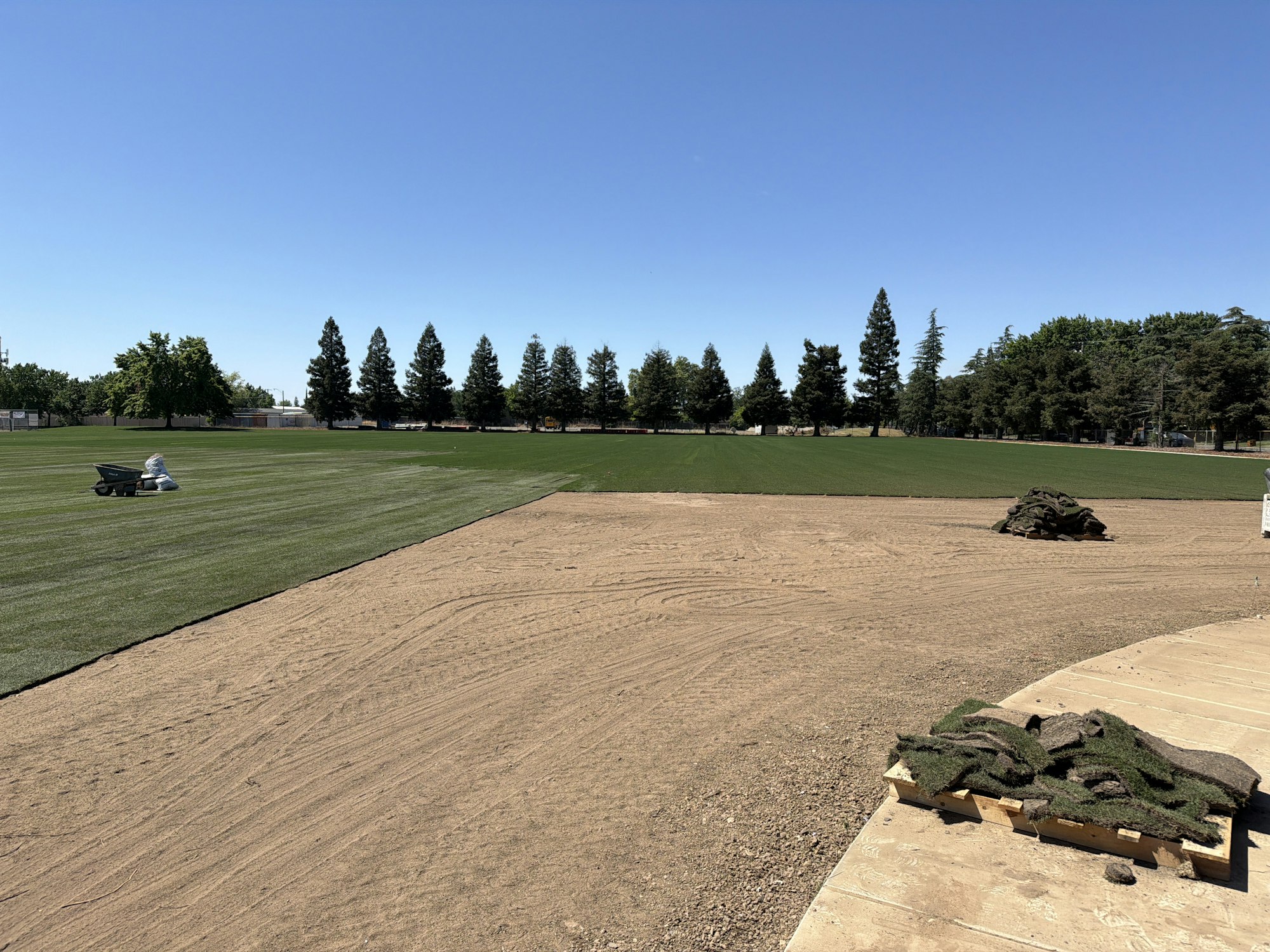

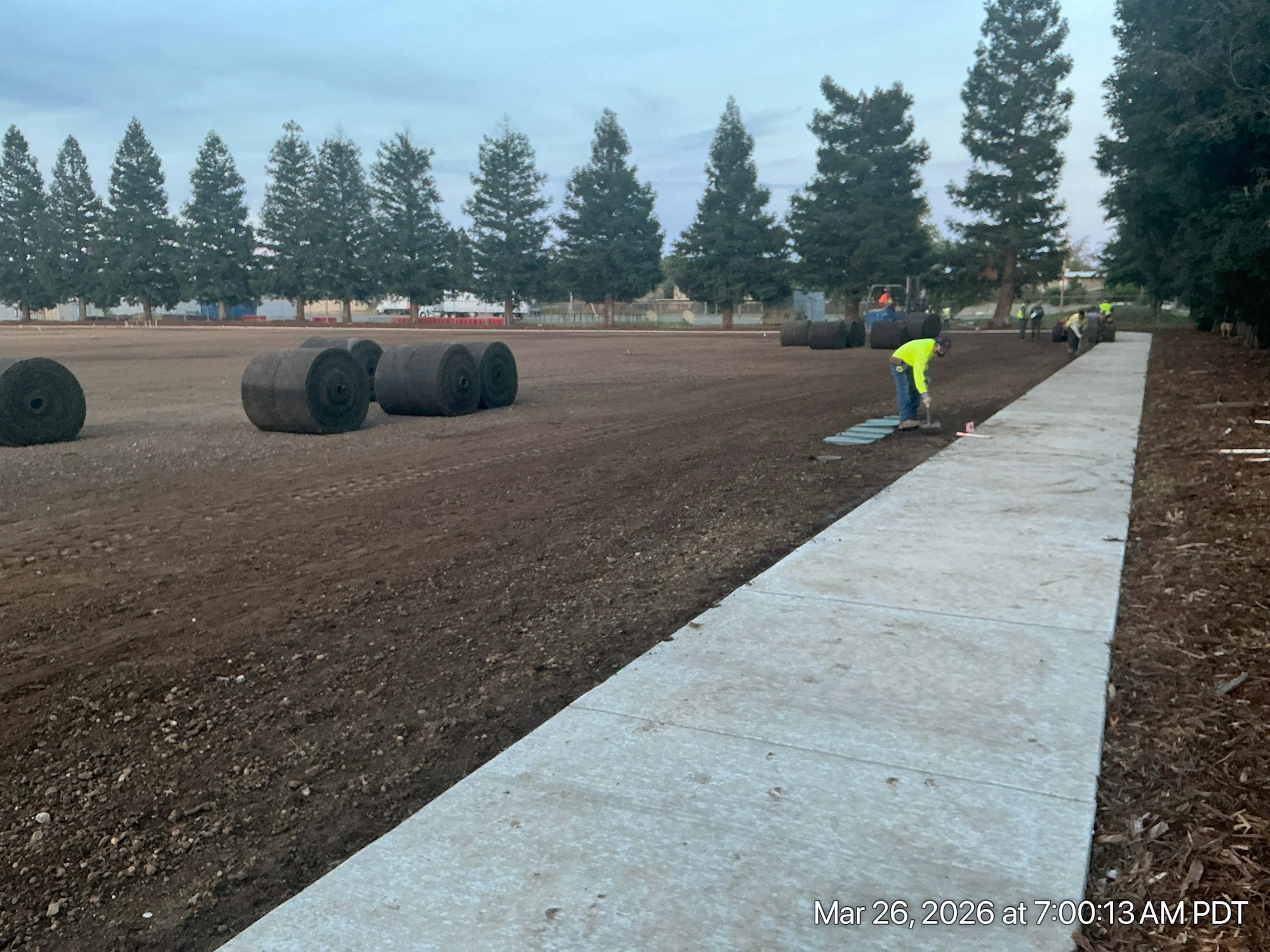

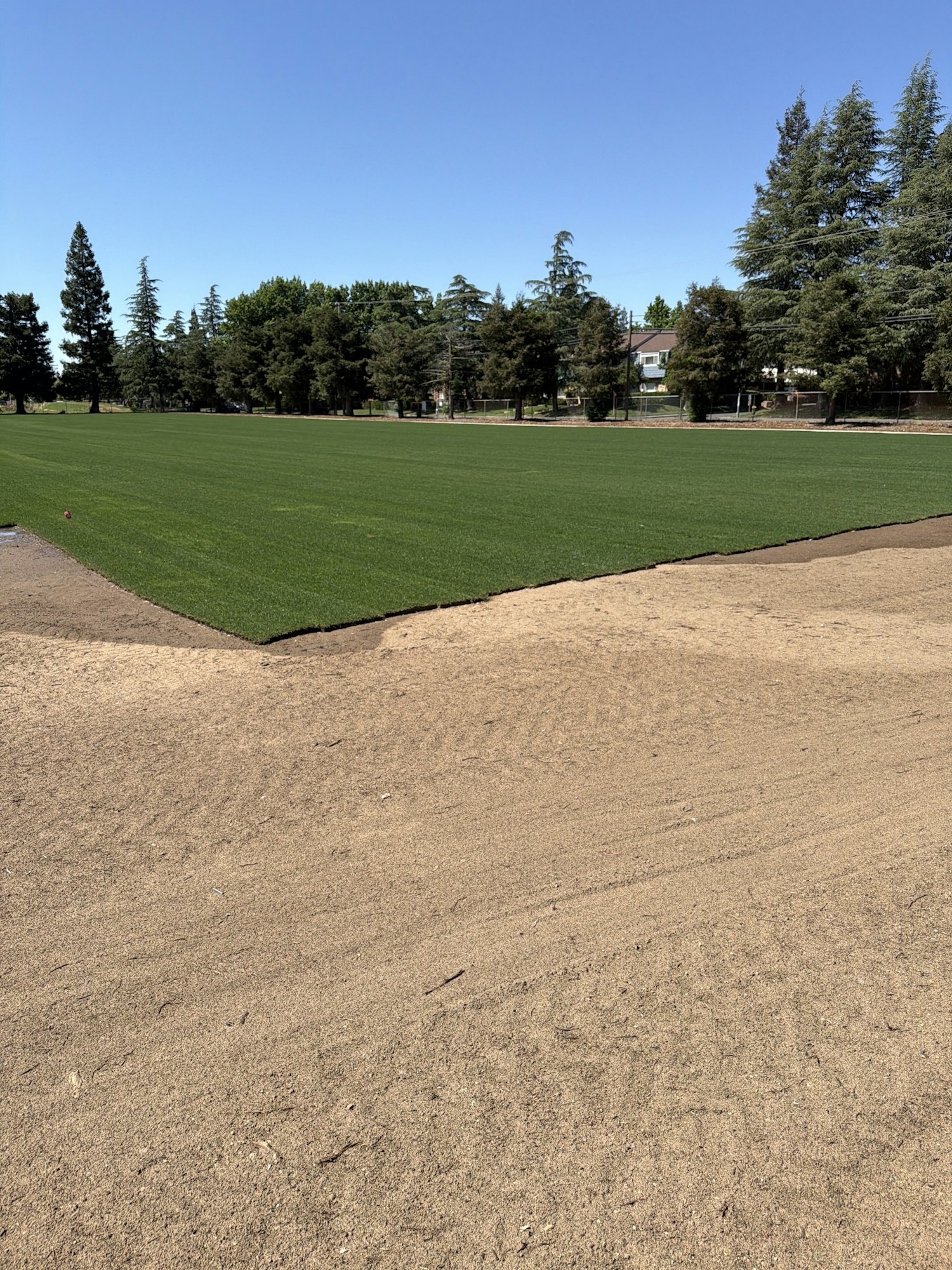

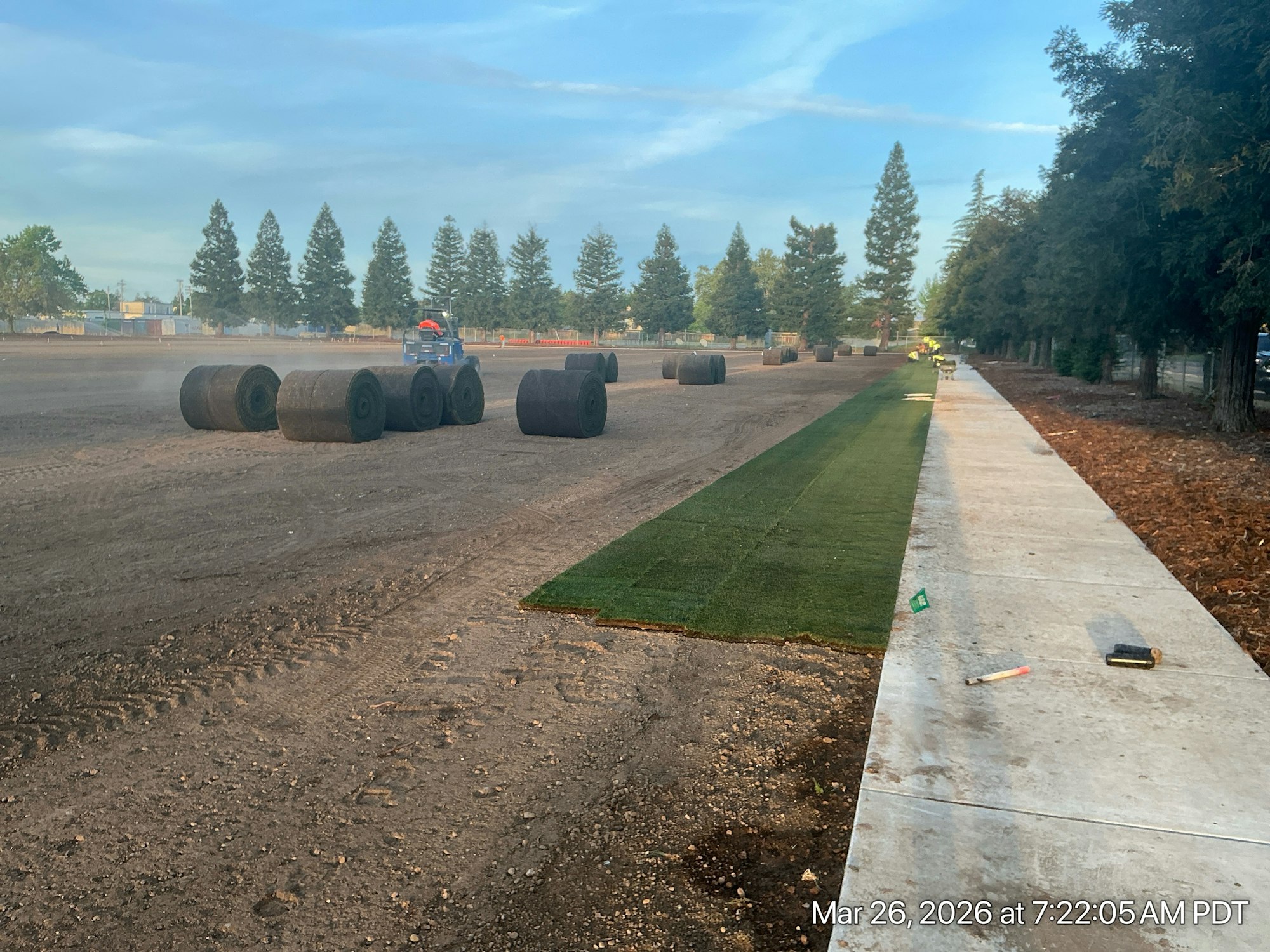

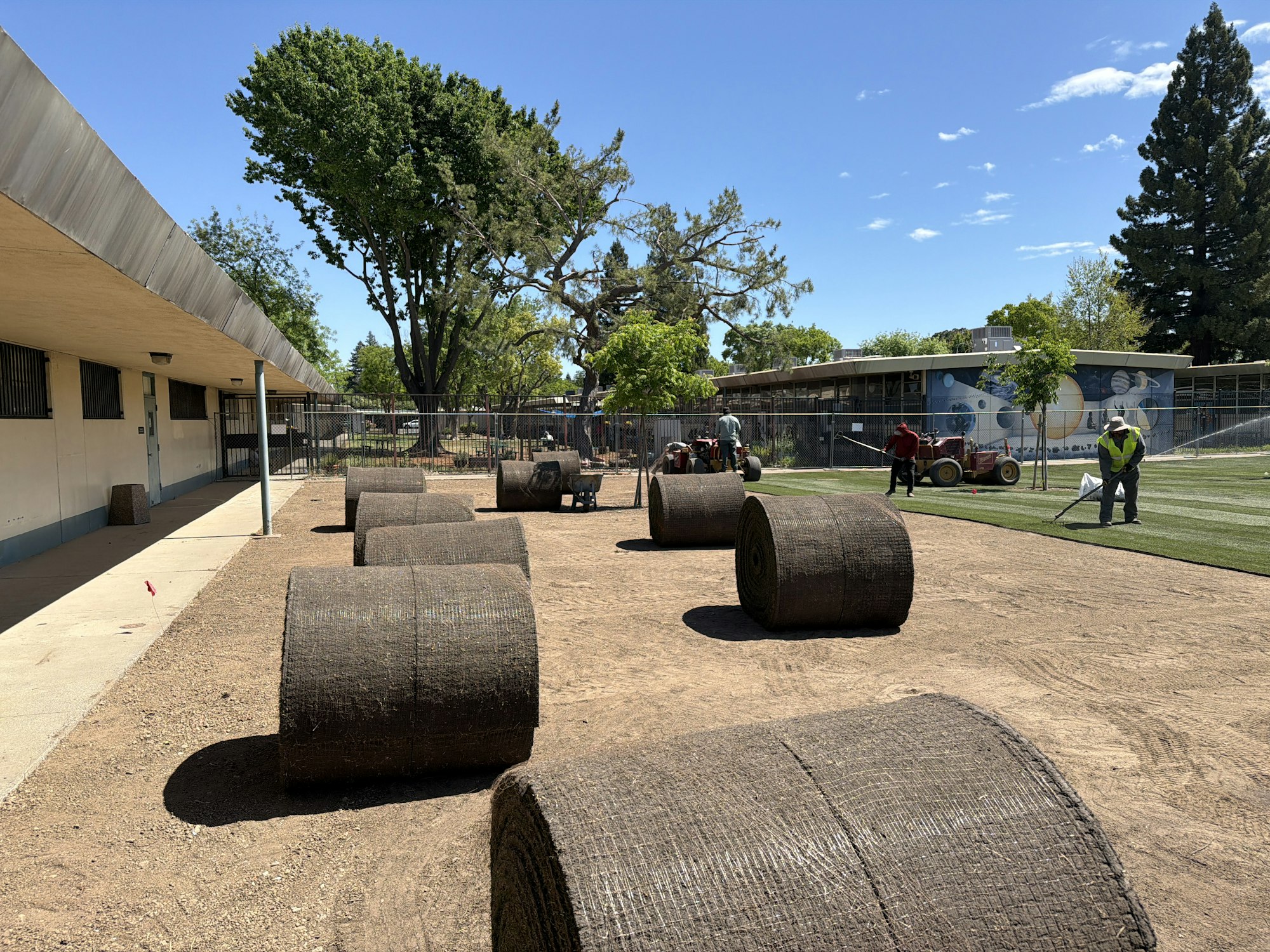

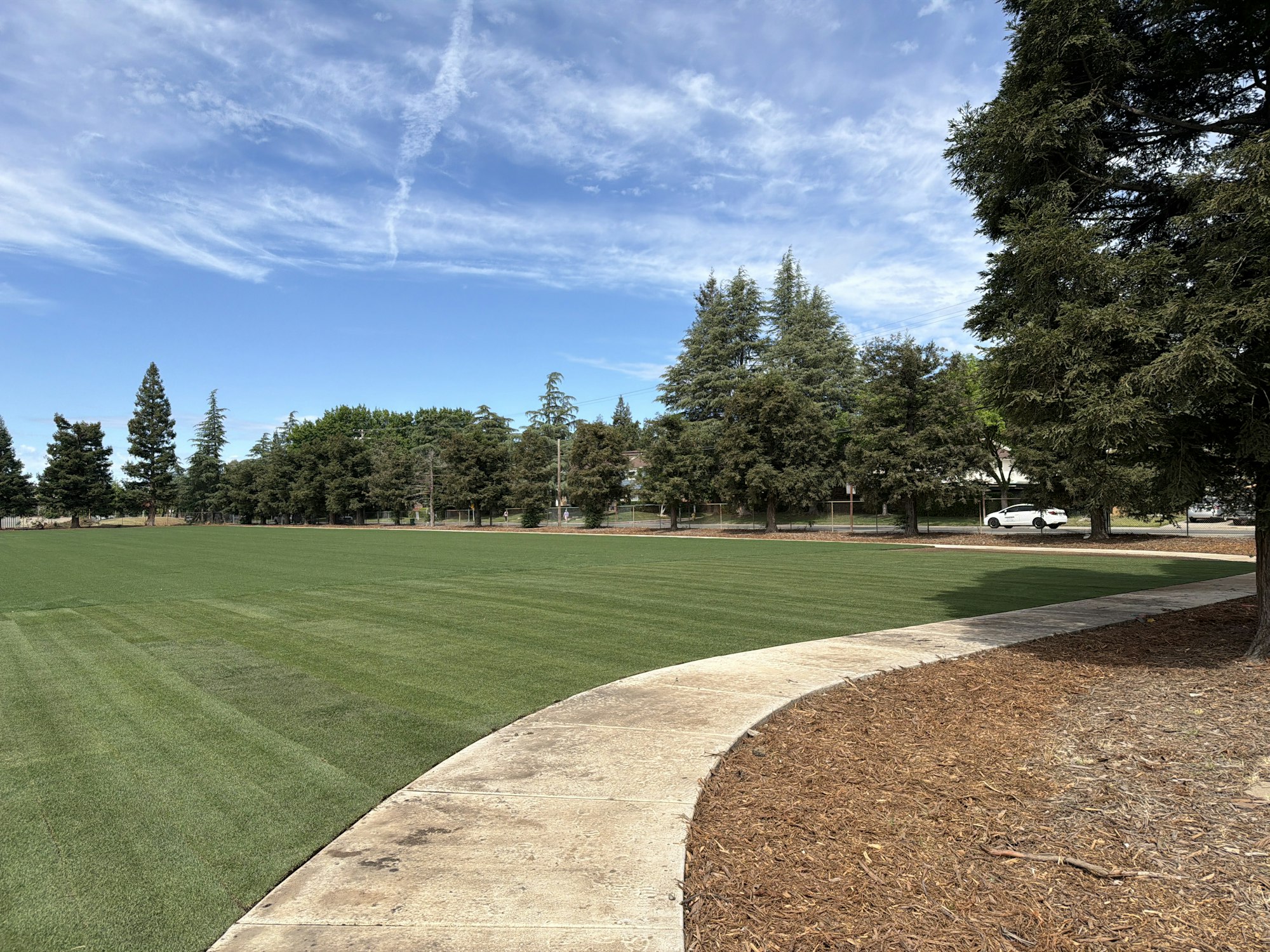

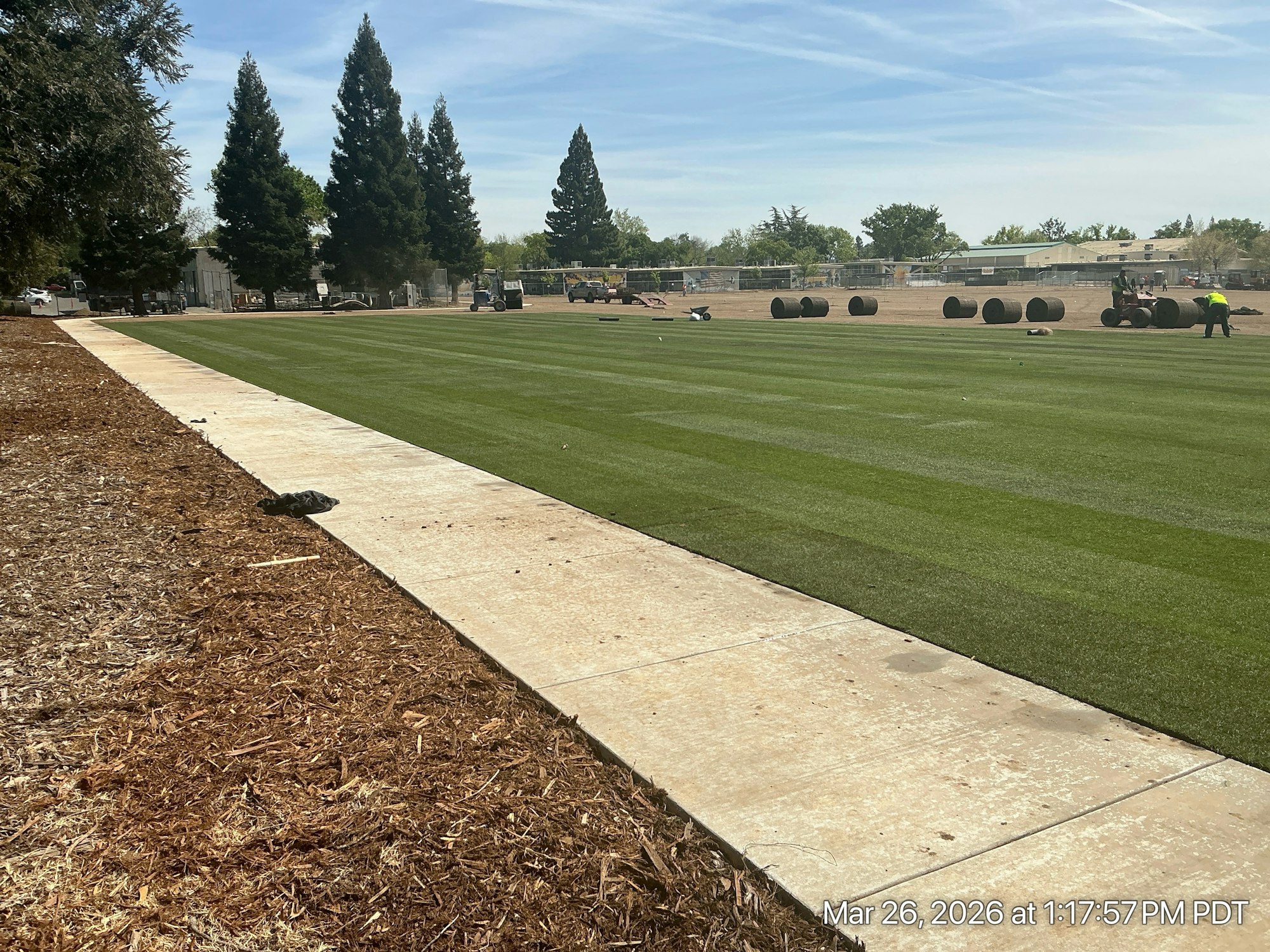

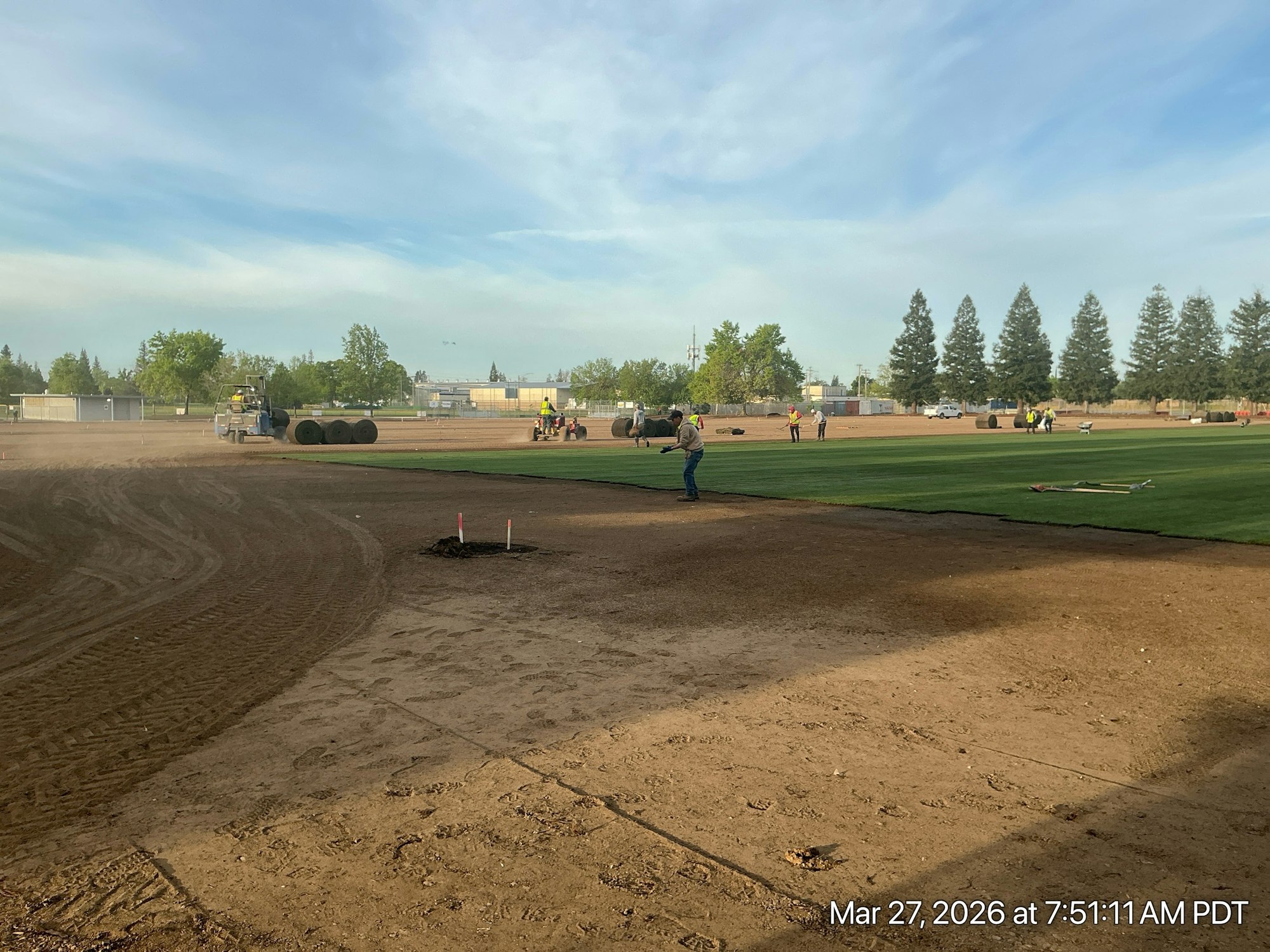

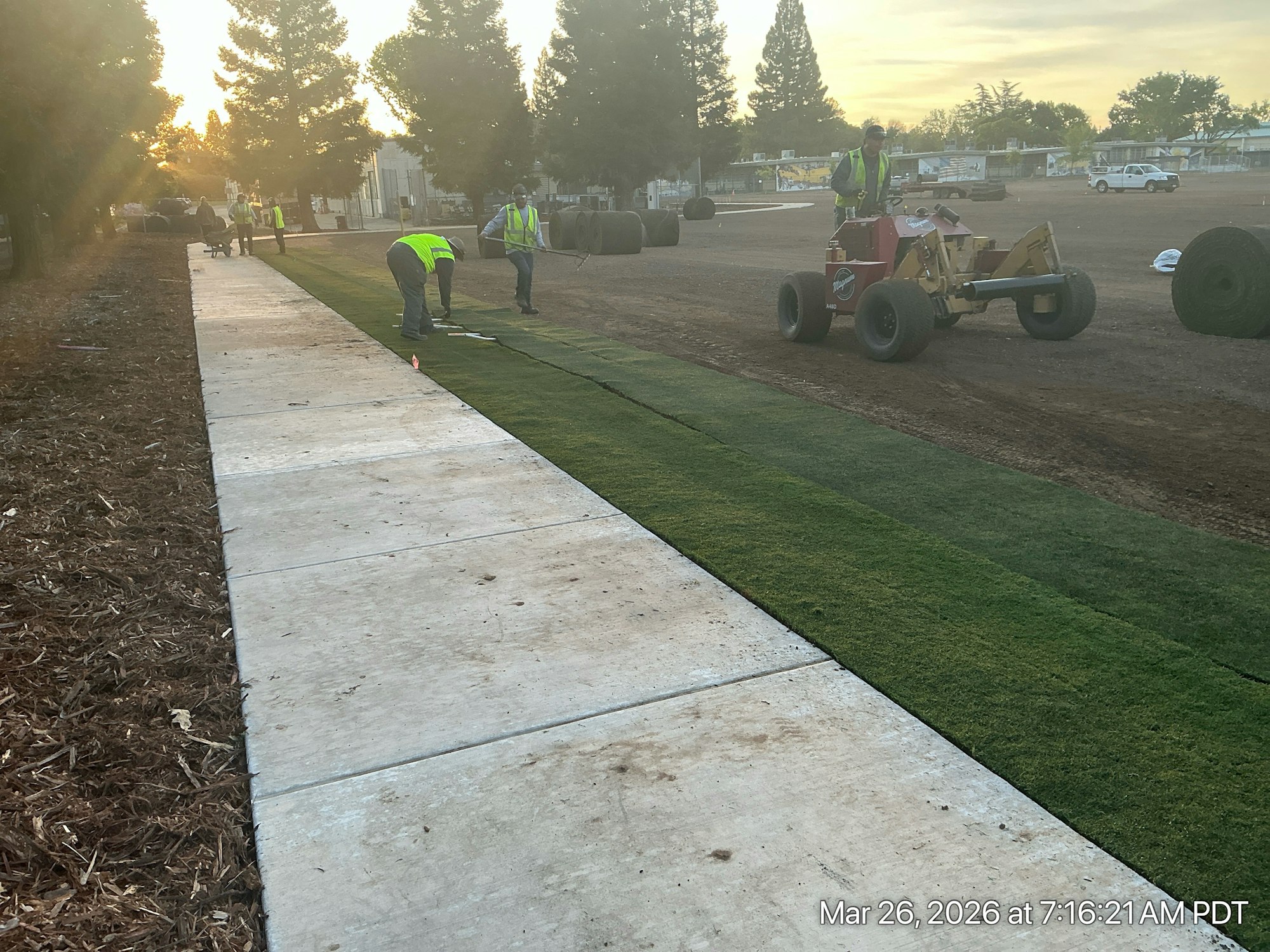

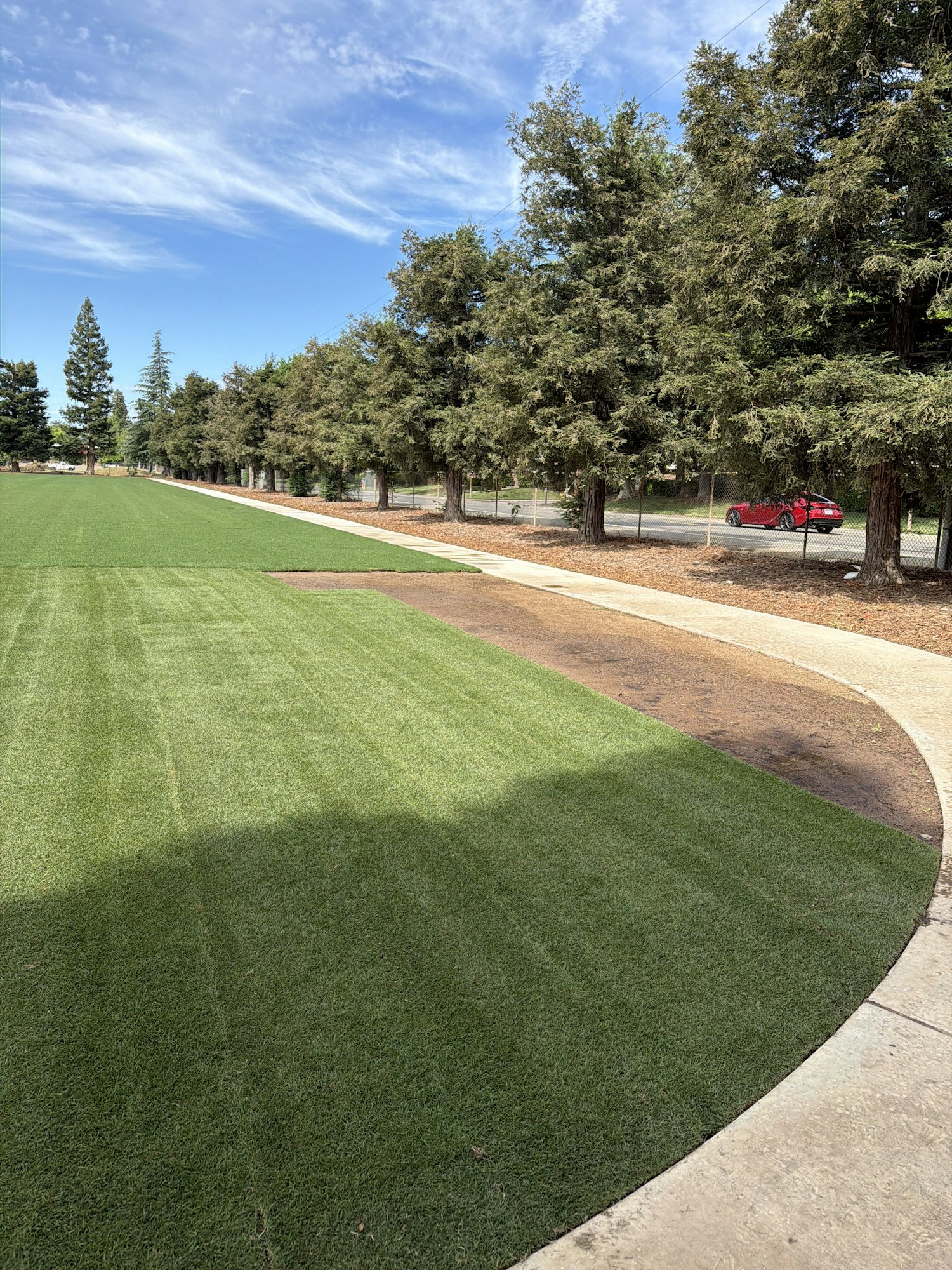

- Current Progress (November 2025) - Pouring concrete for new pathways continues. Lateral irrigation lines are being installed. New sod is scheduled to be put in next month!

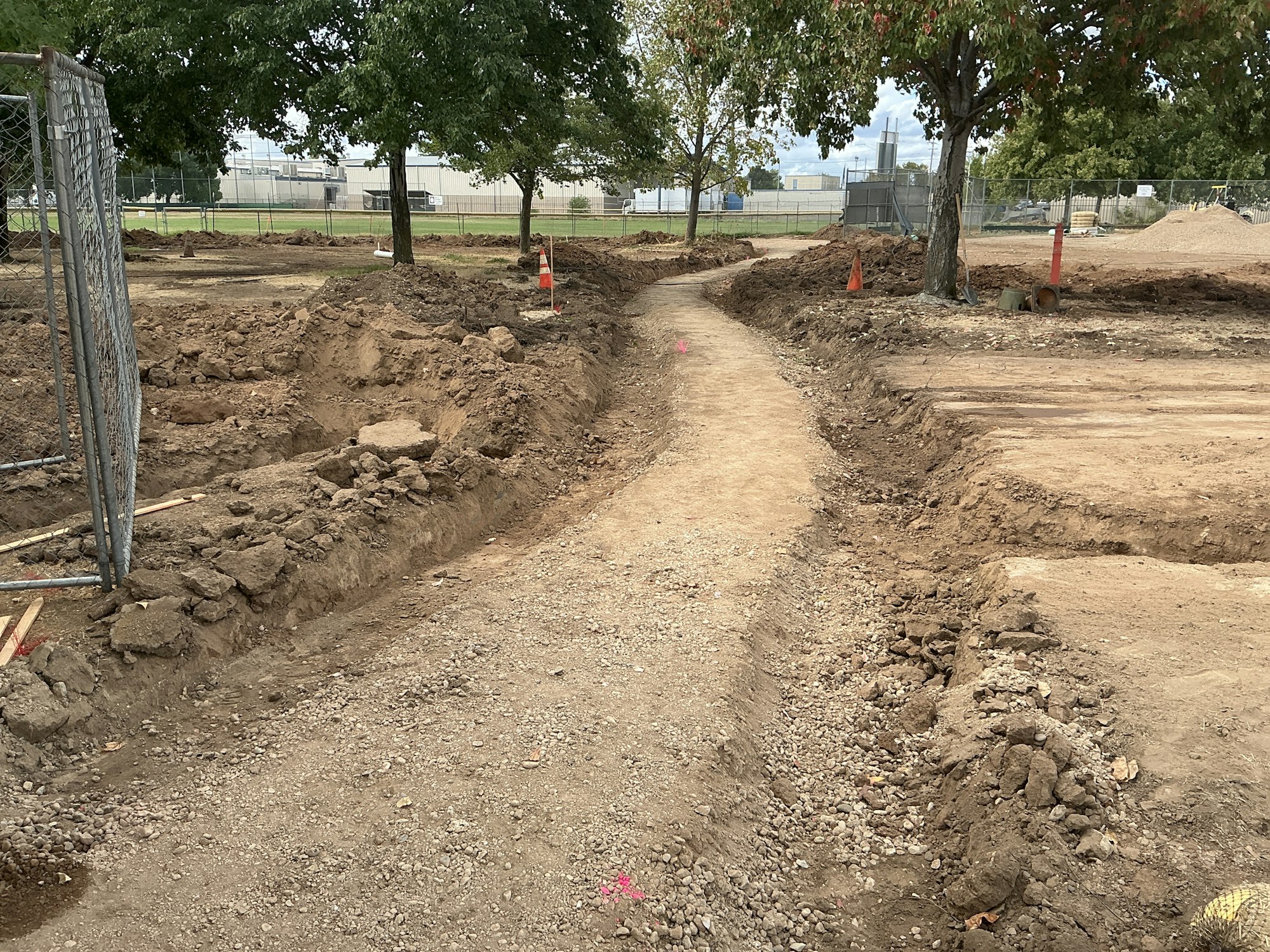

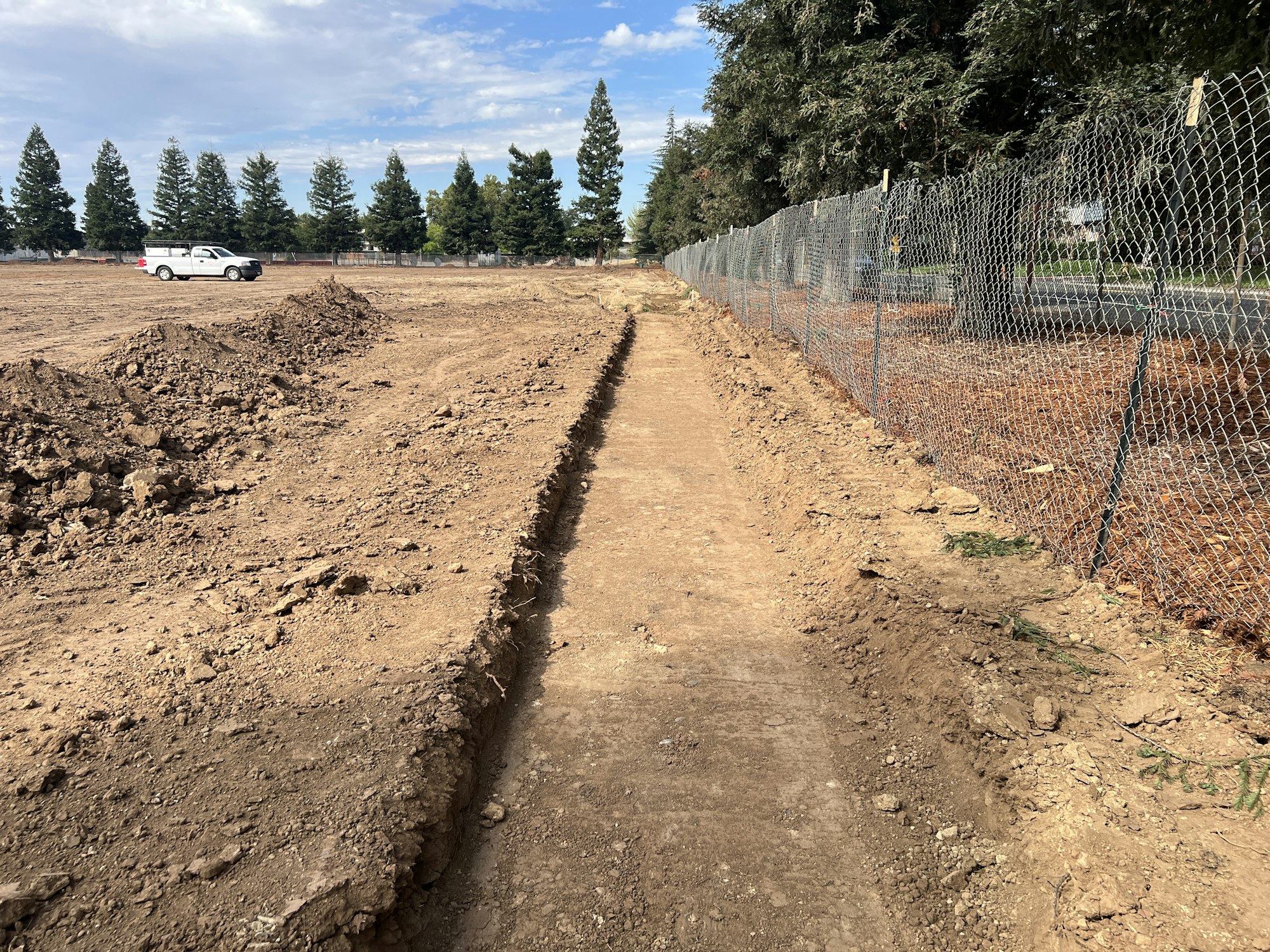

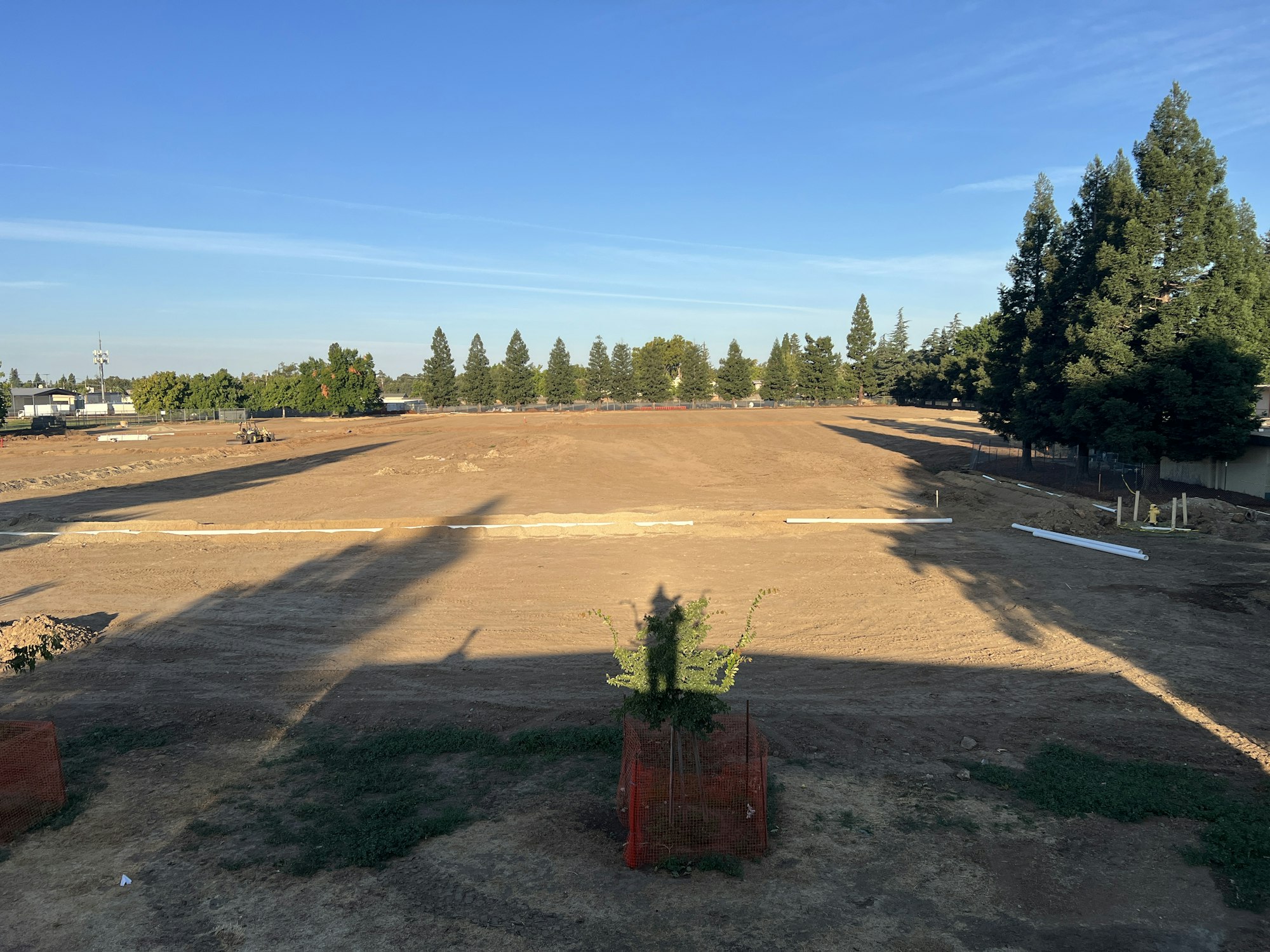

- October 2025 - New concrete pathway preparation continues.

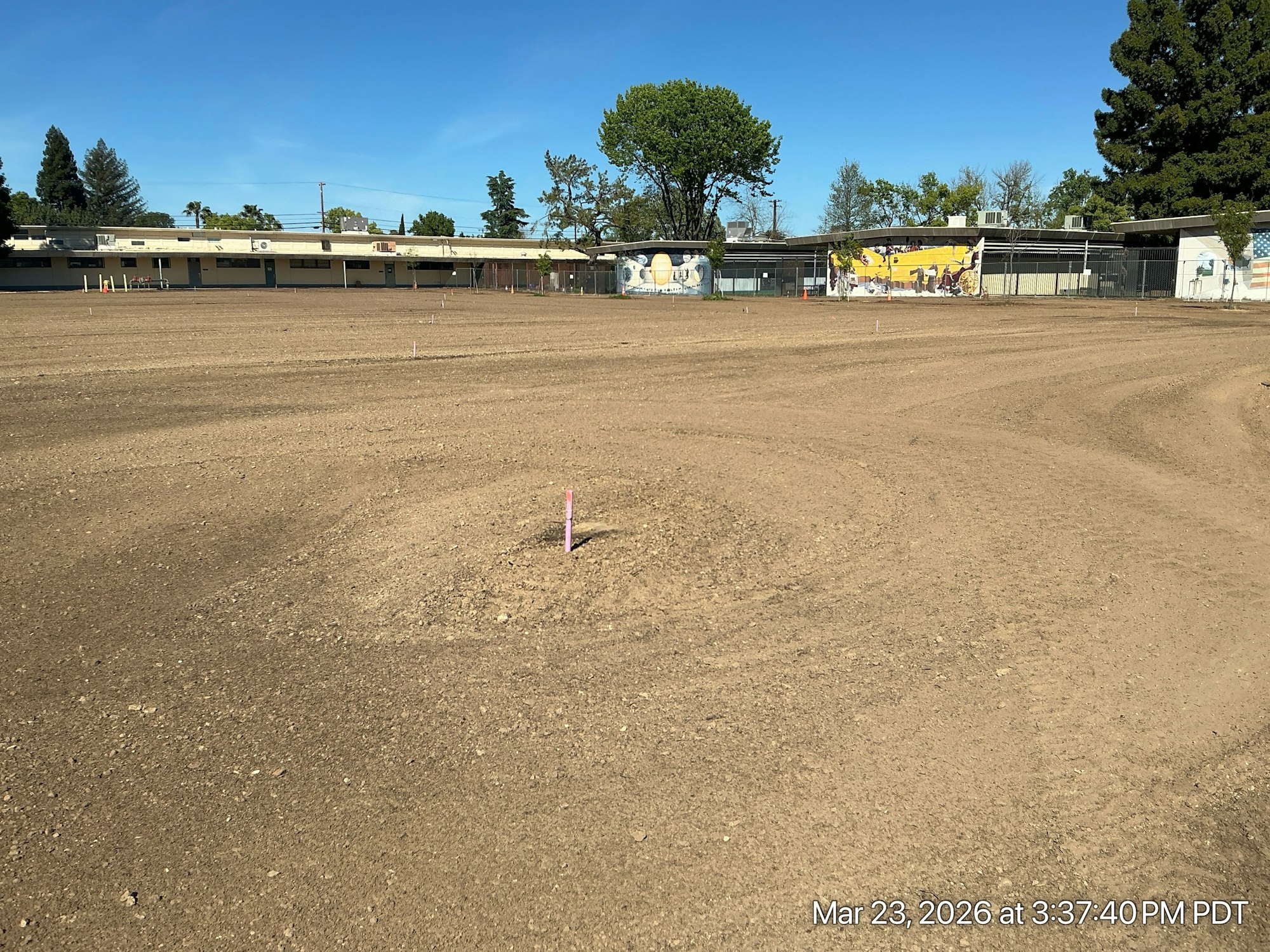

- September 2025 - Irrigation installation is underway. Beginning preparation for the concrete pathways.

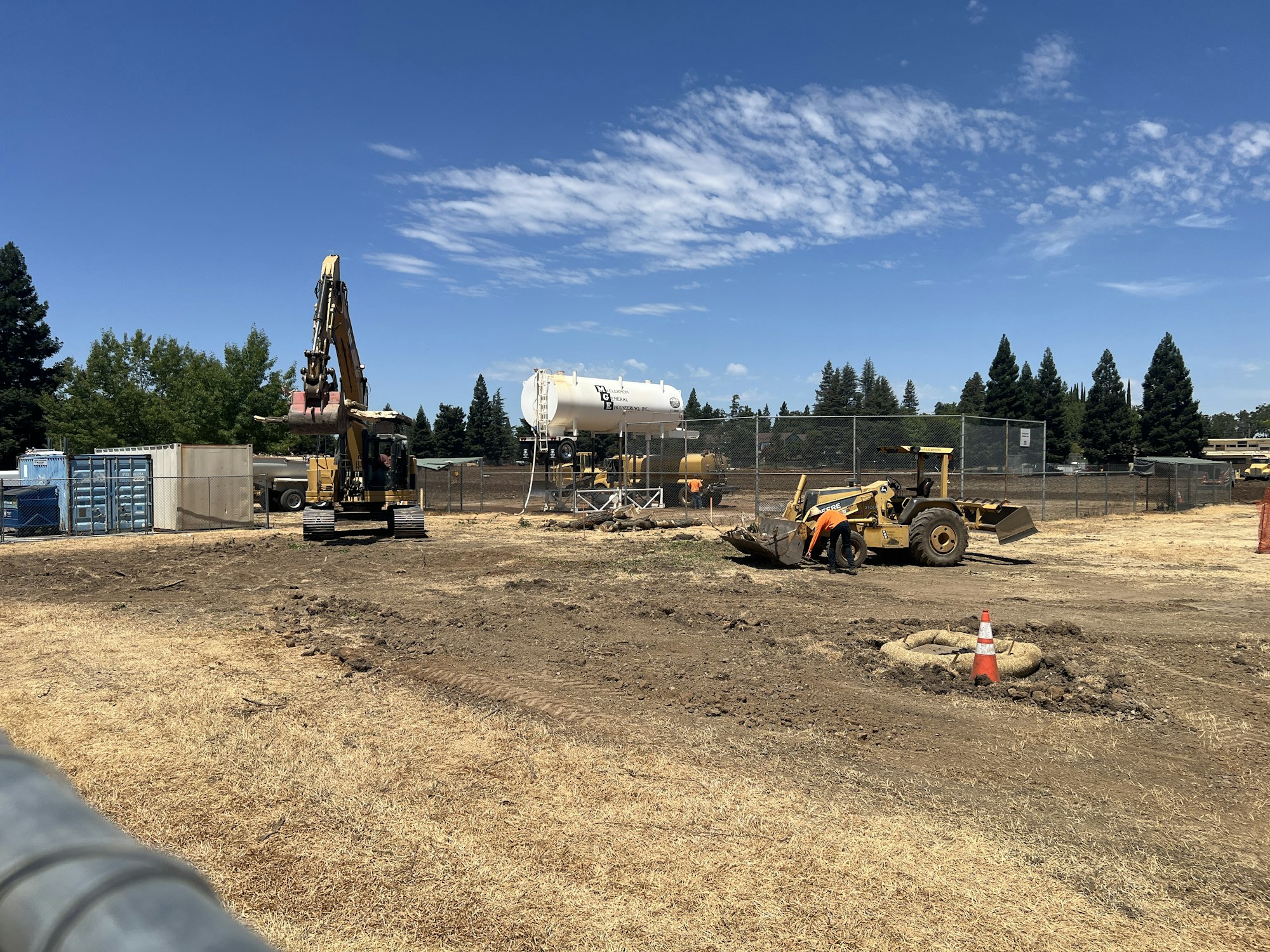

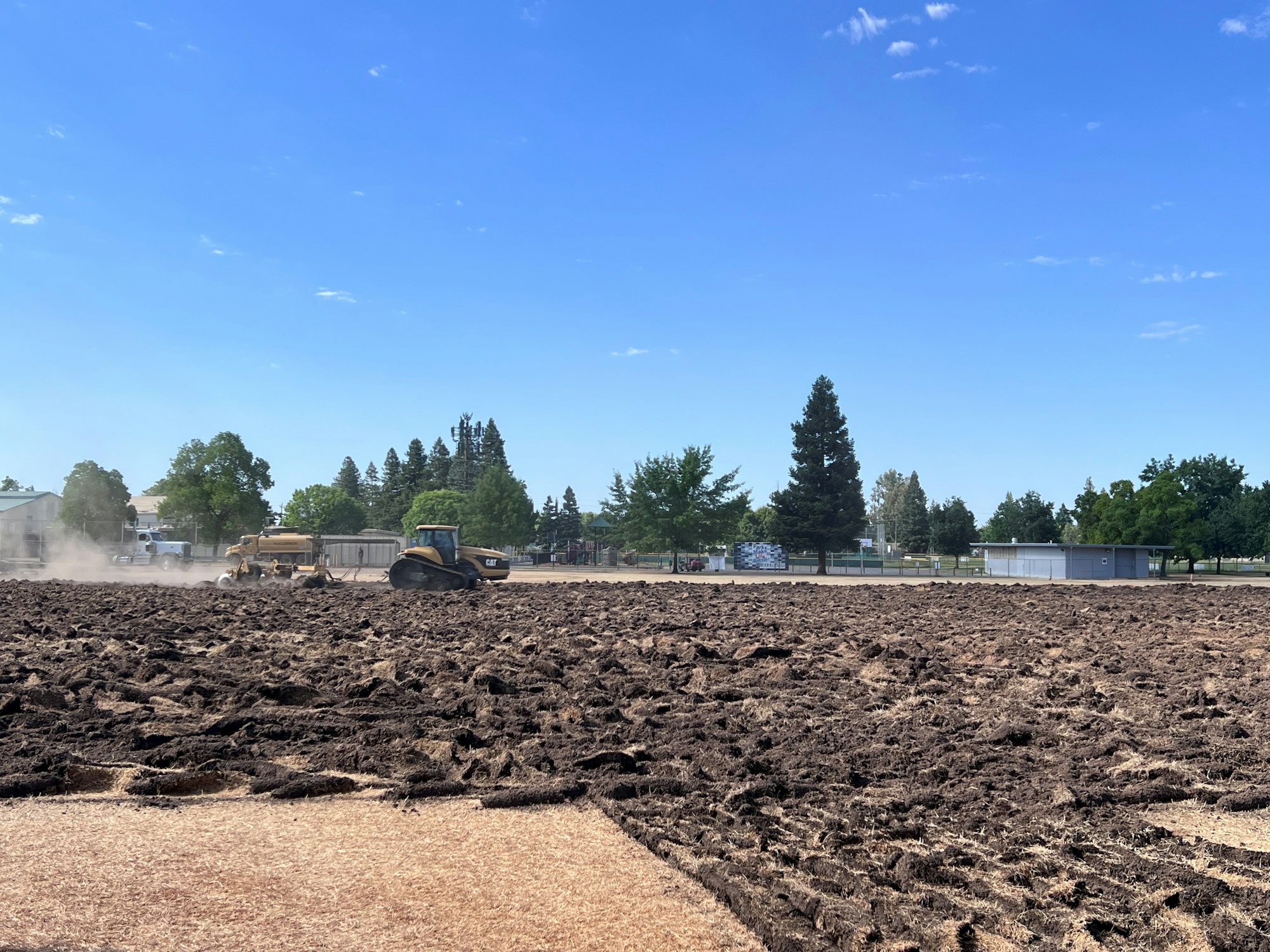

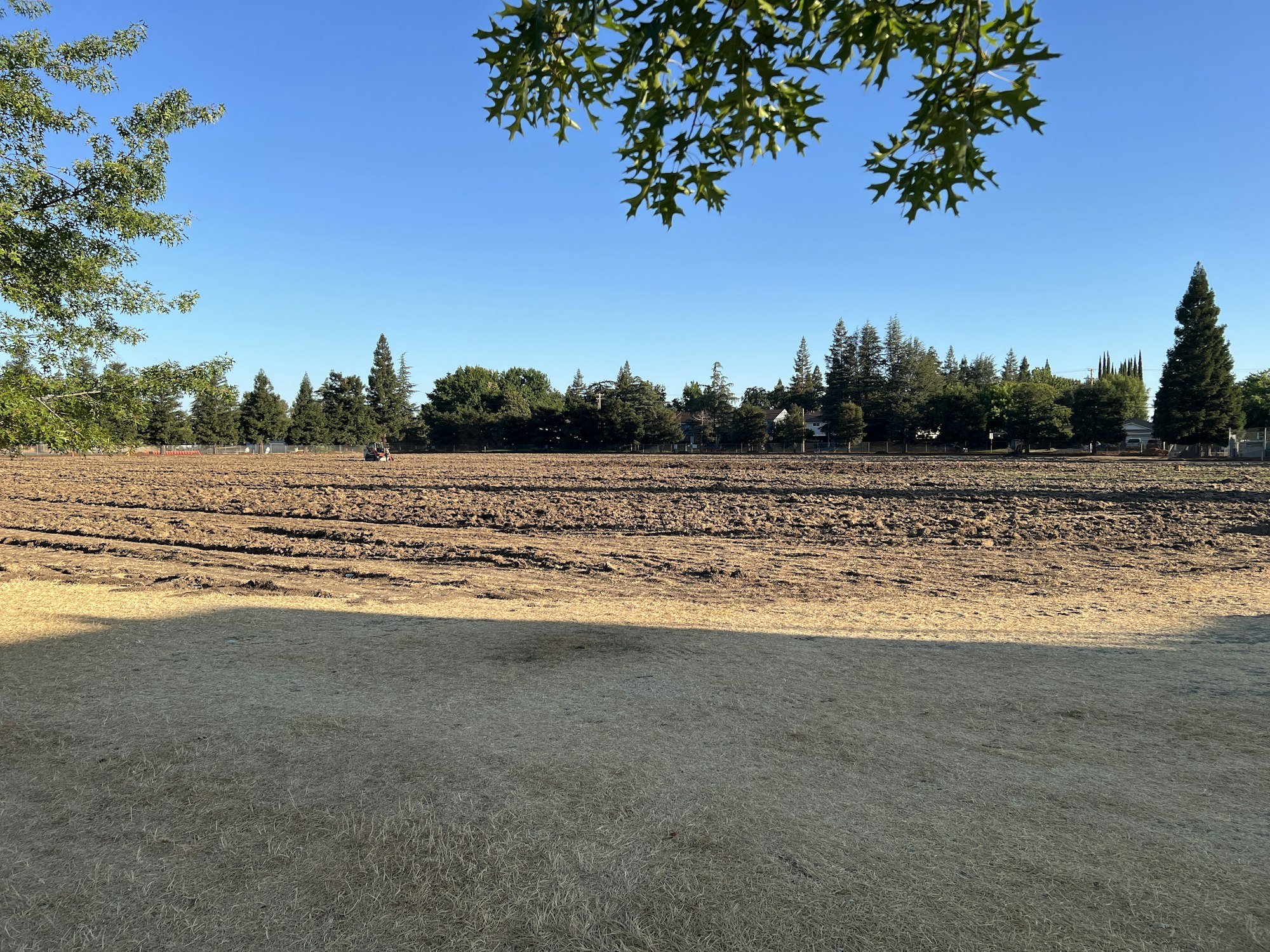

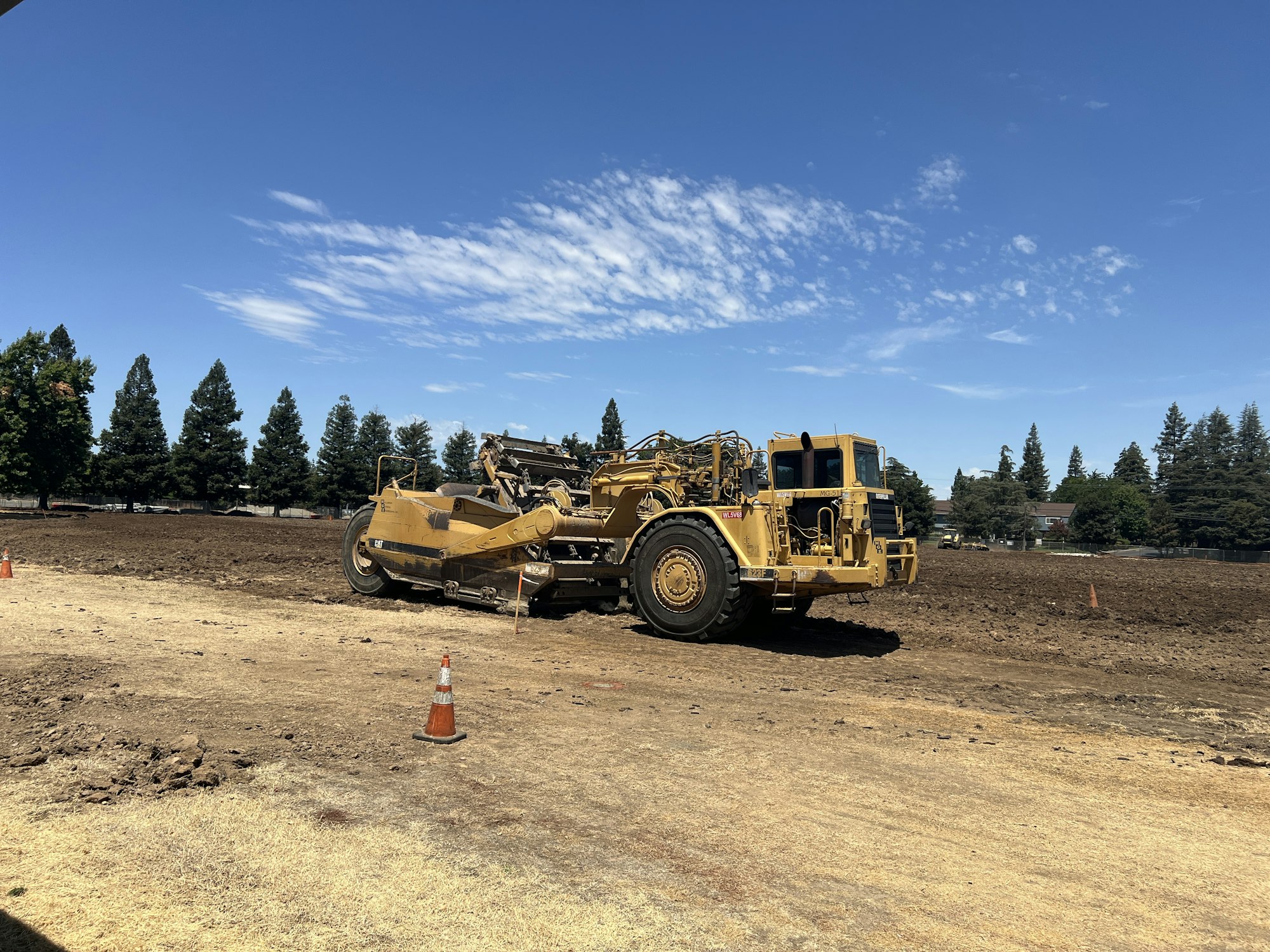

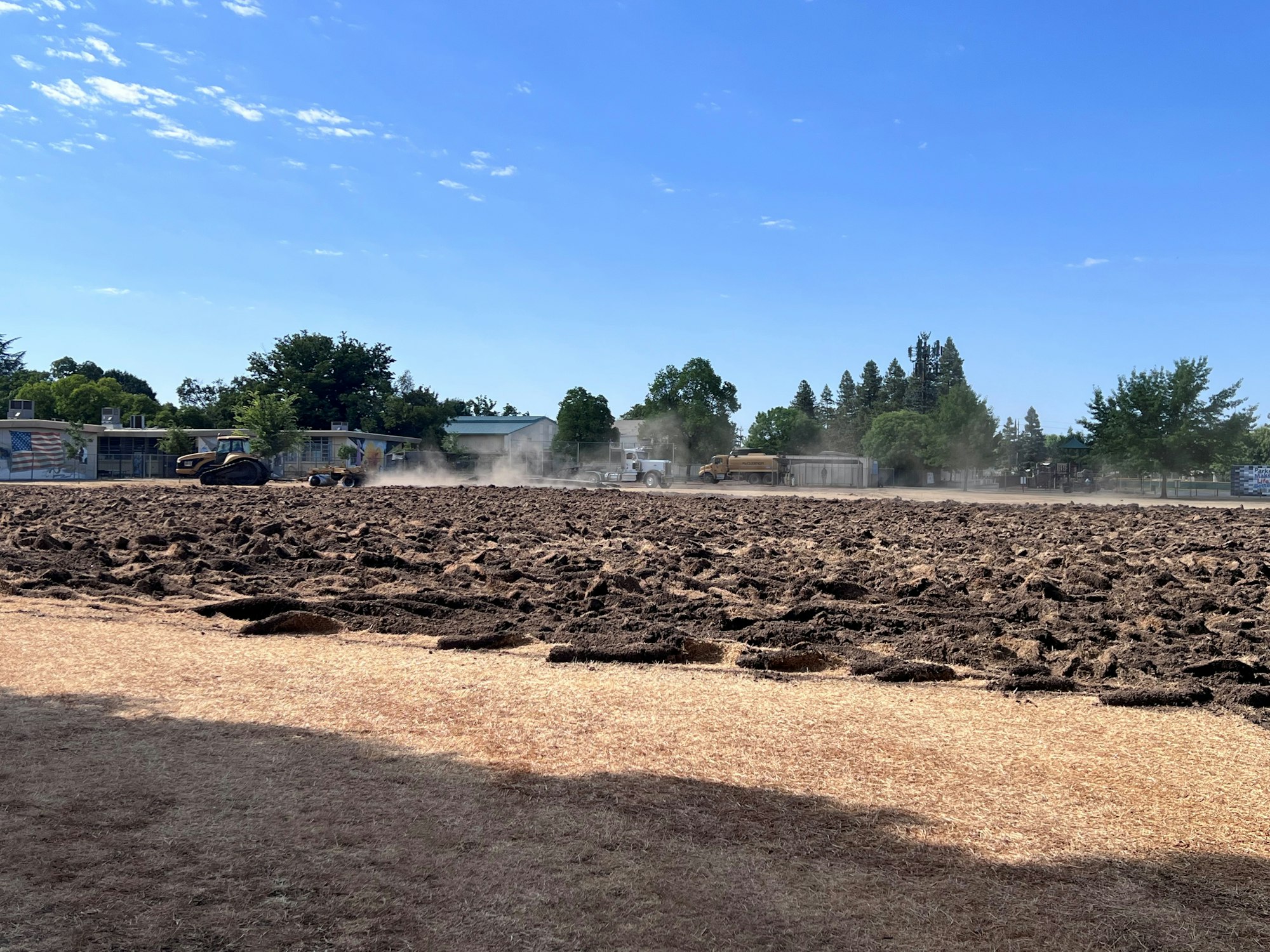

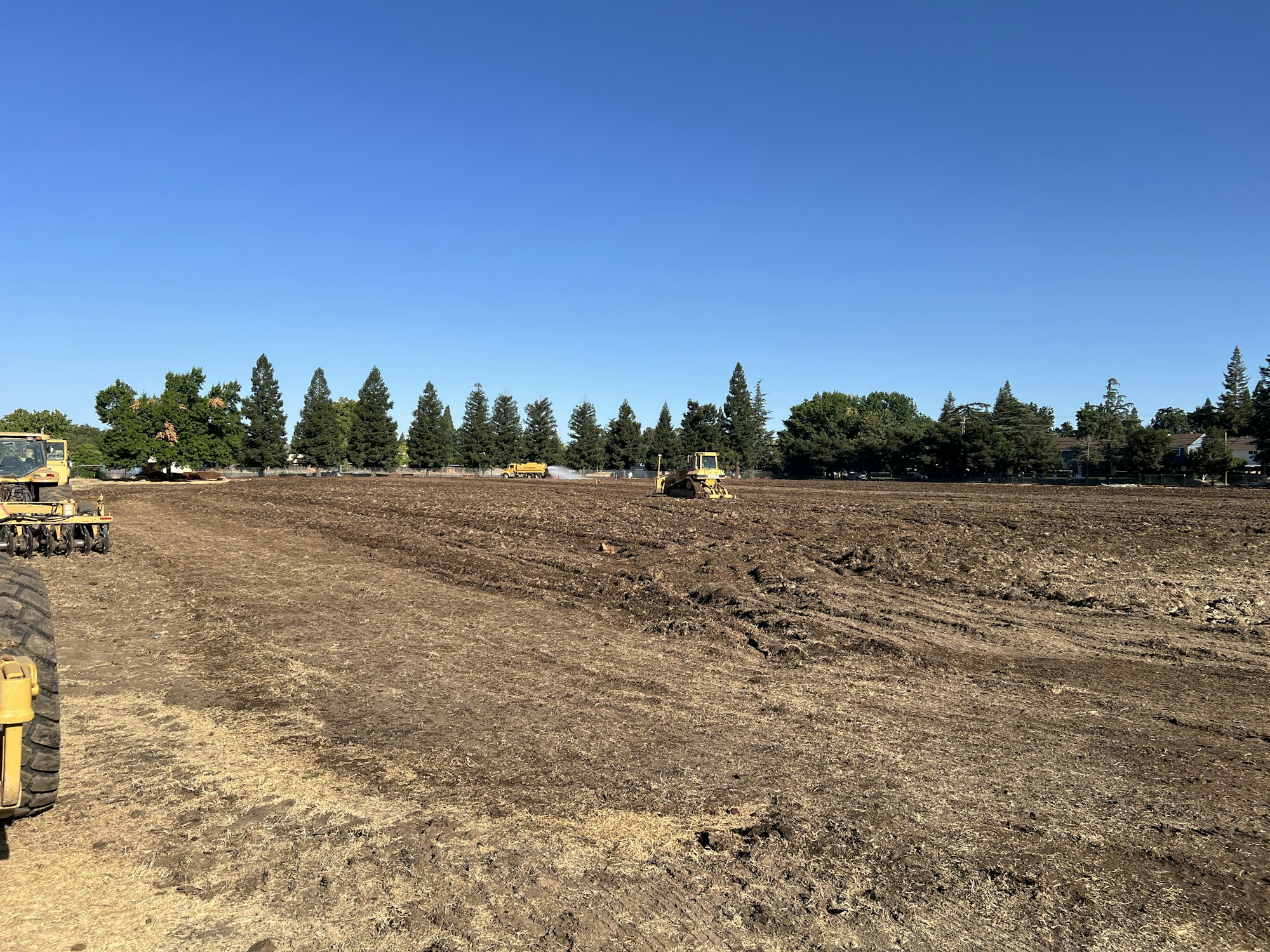

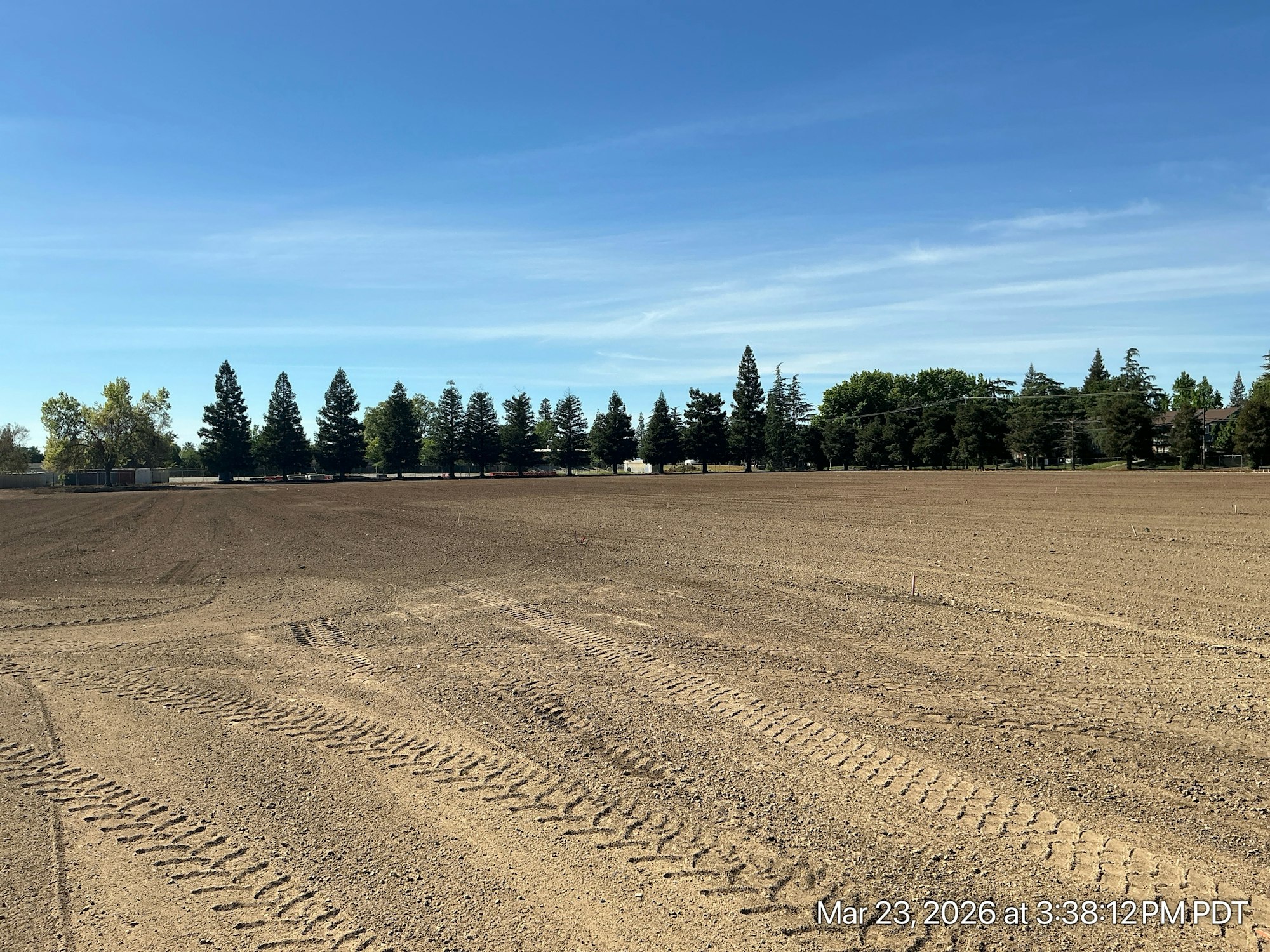

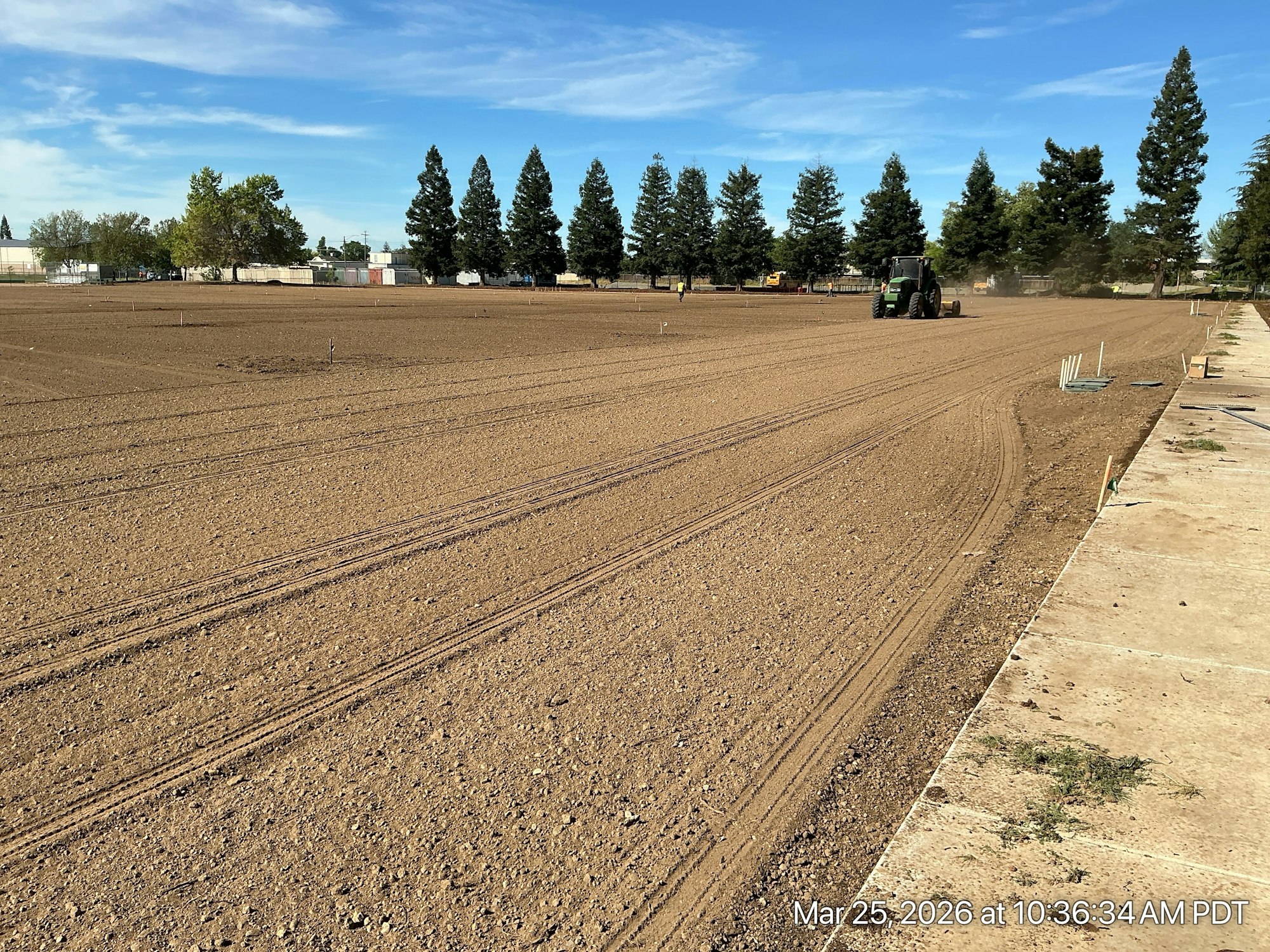

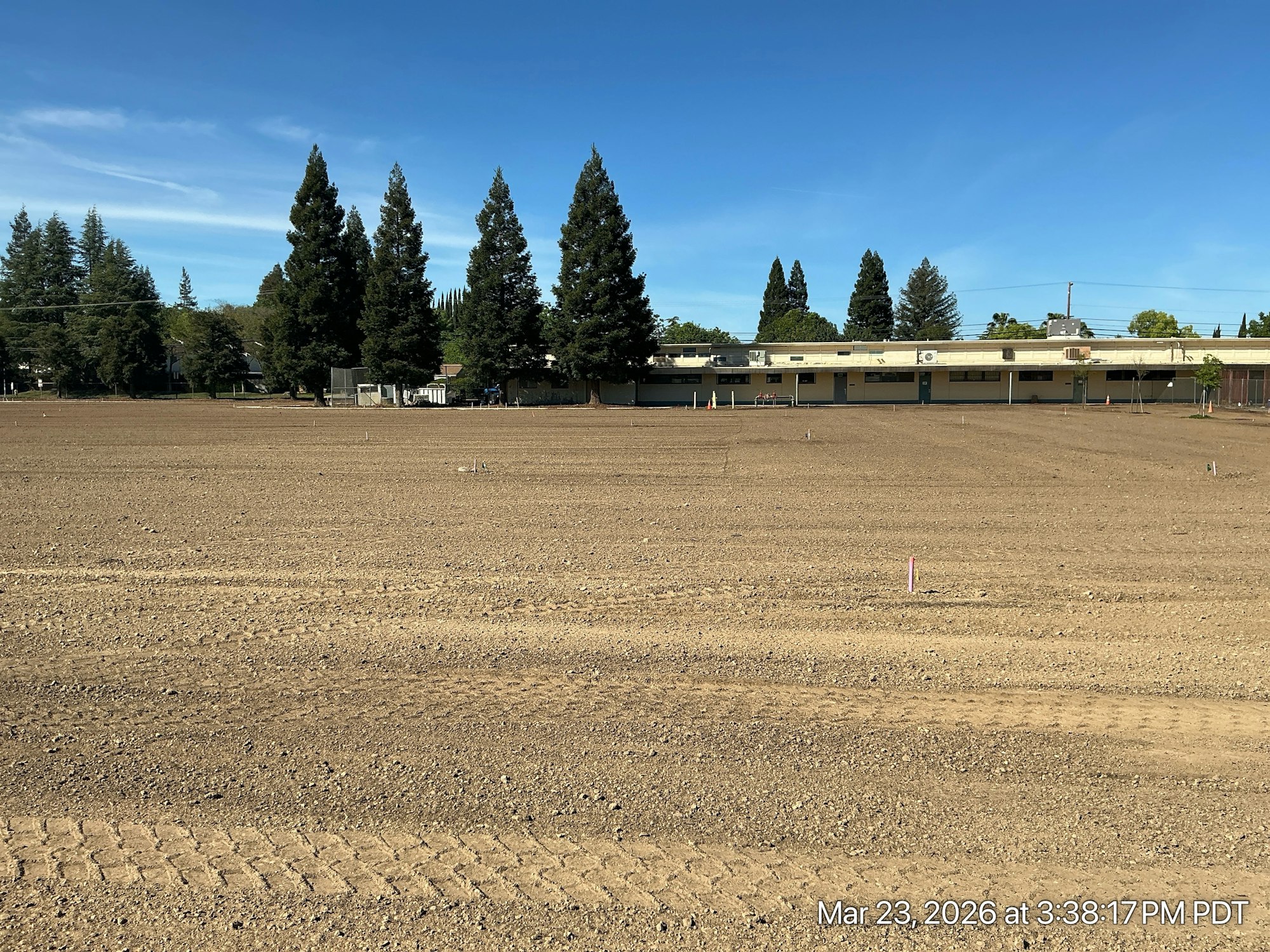

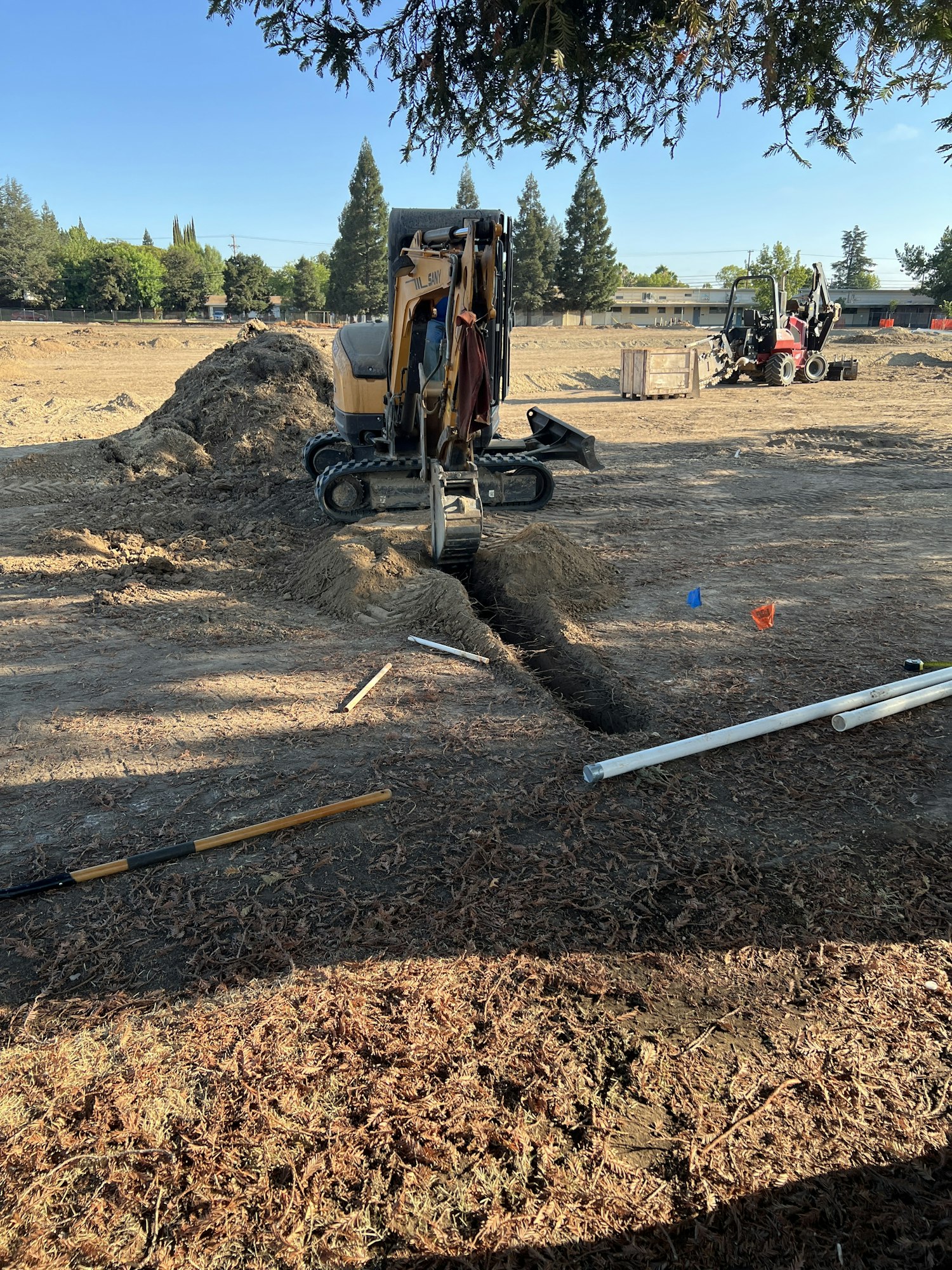

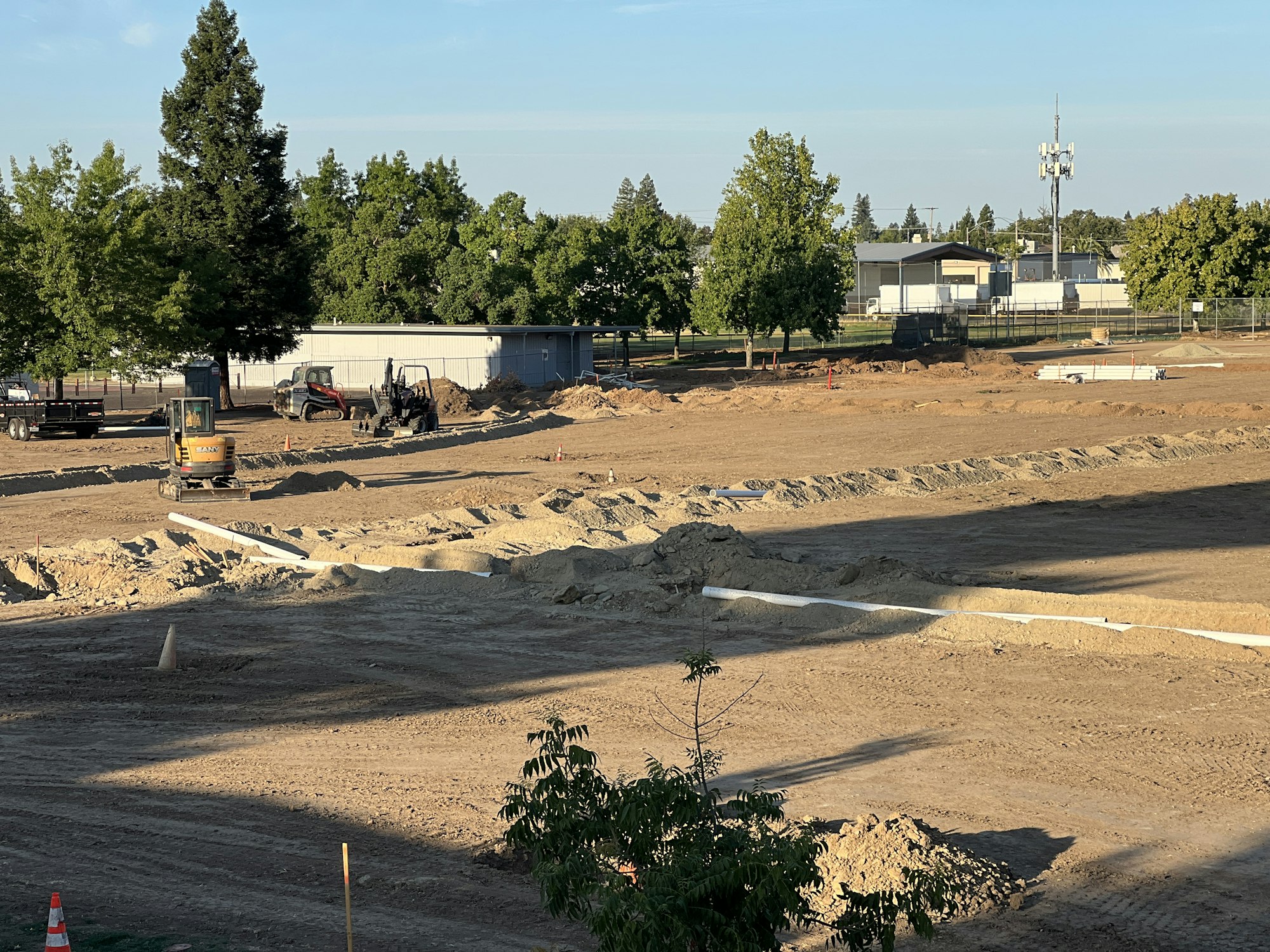

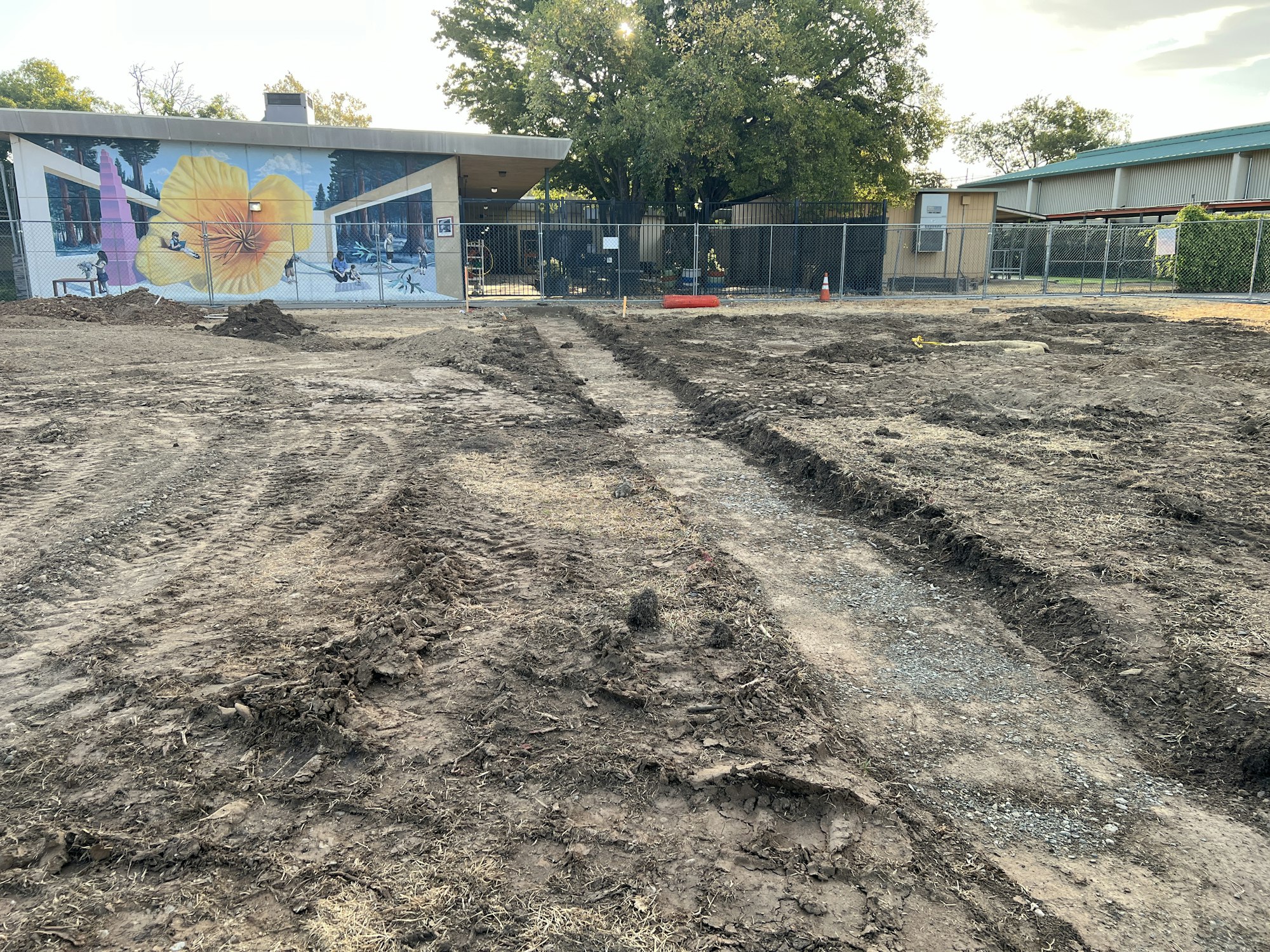

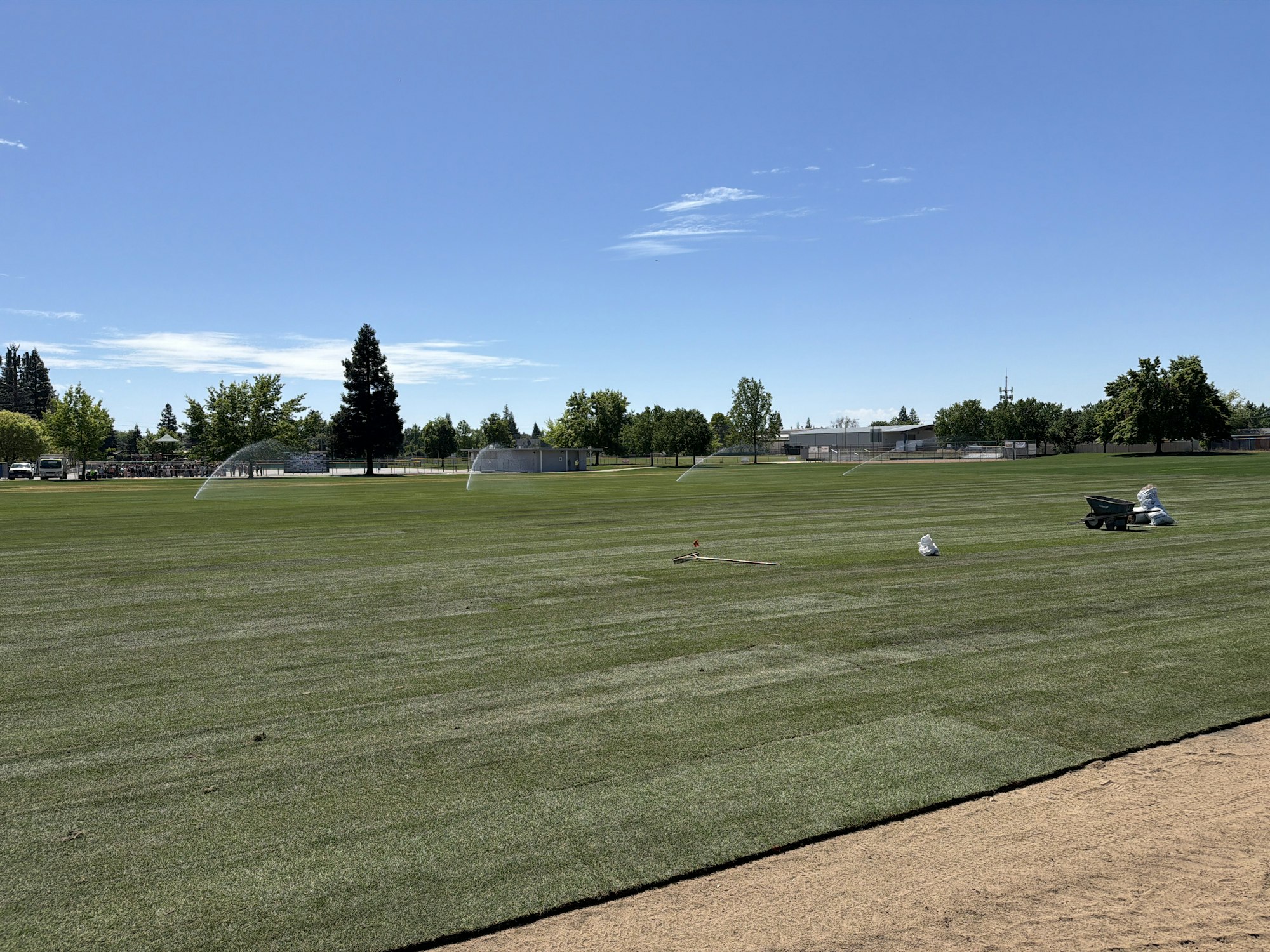

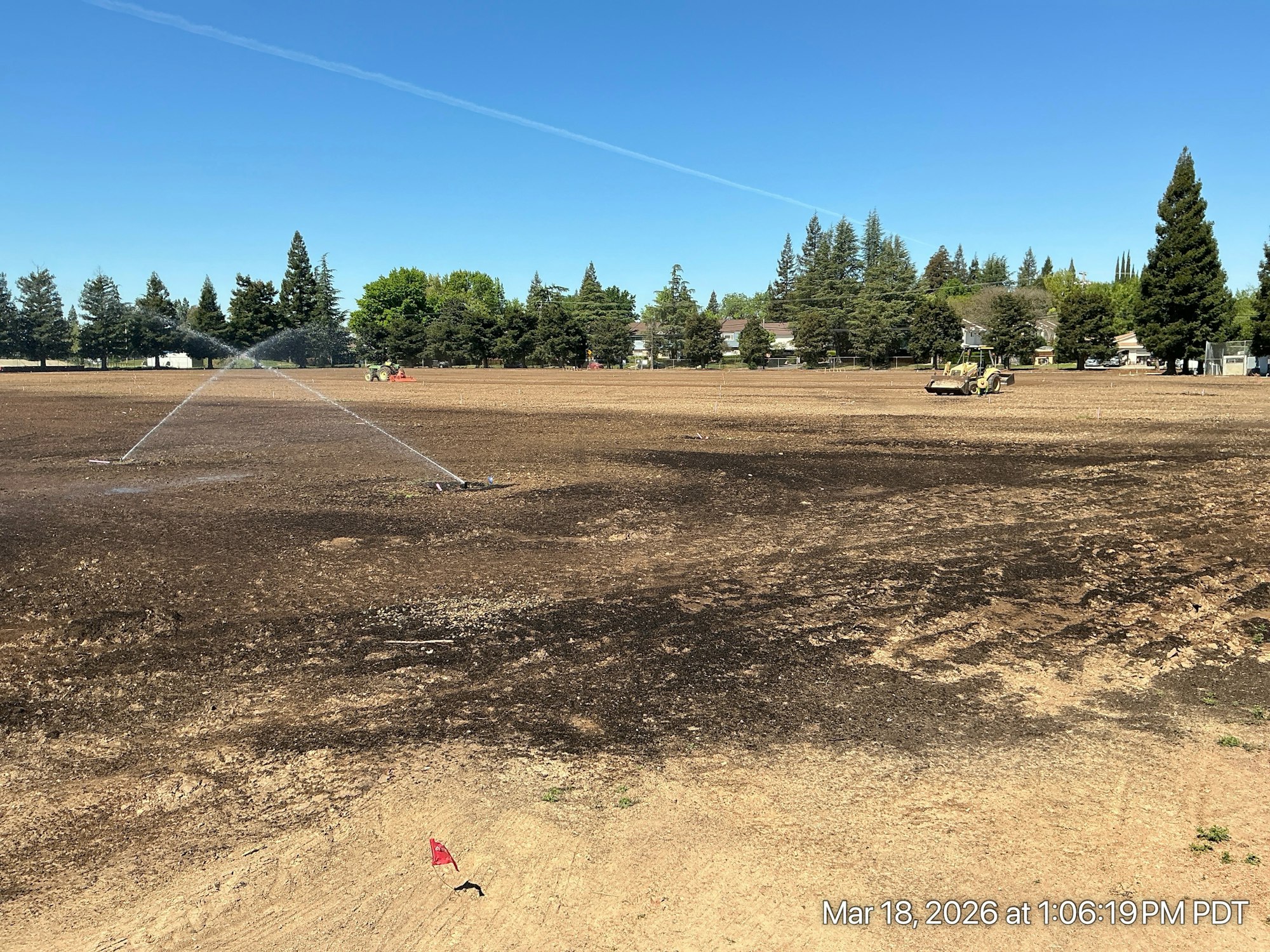

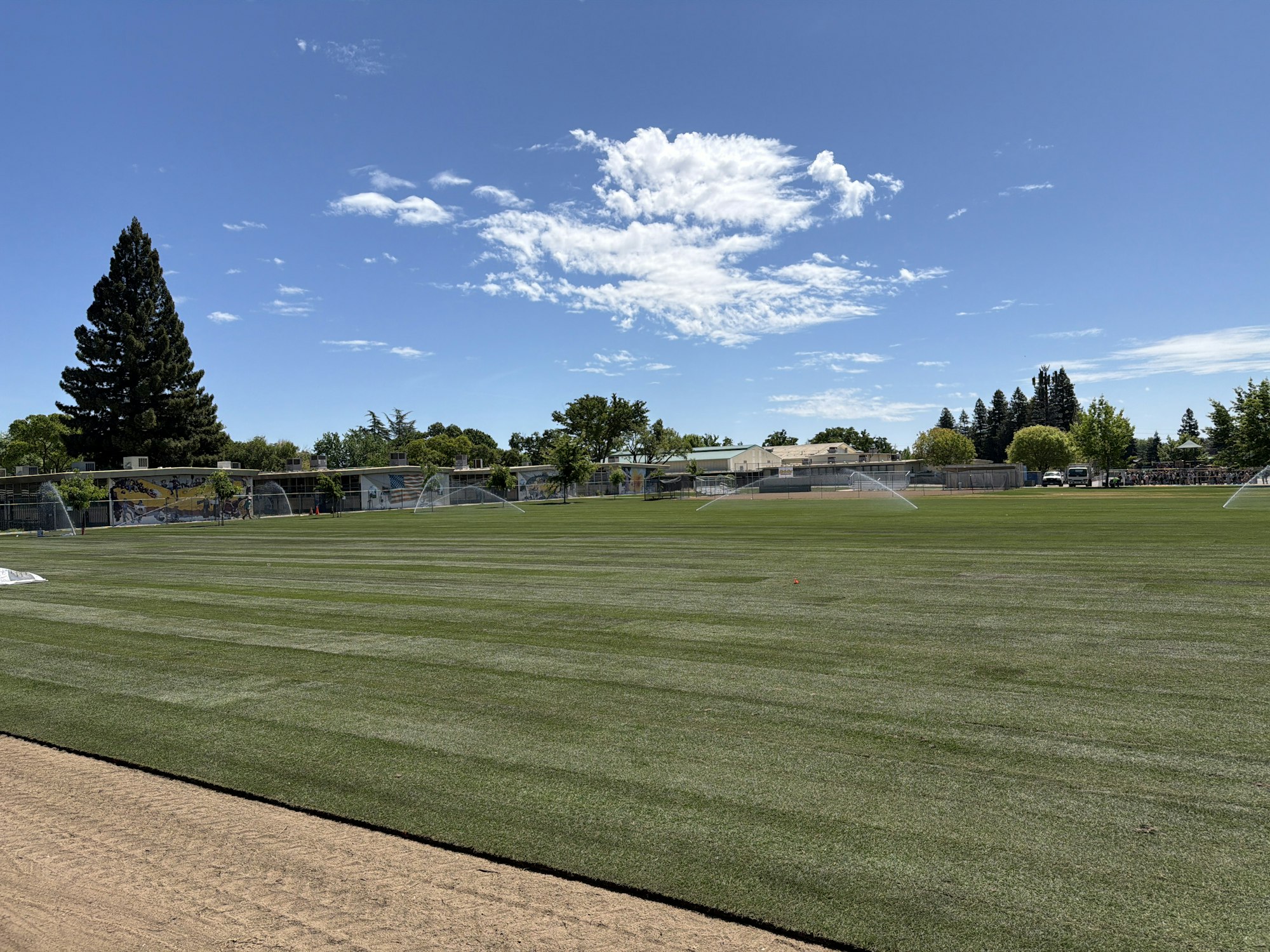

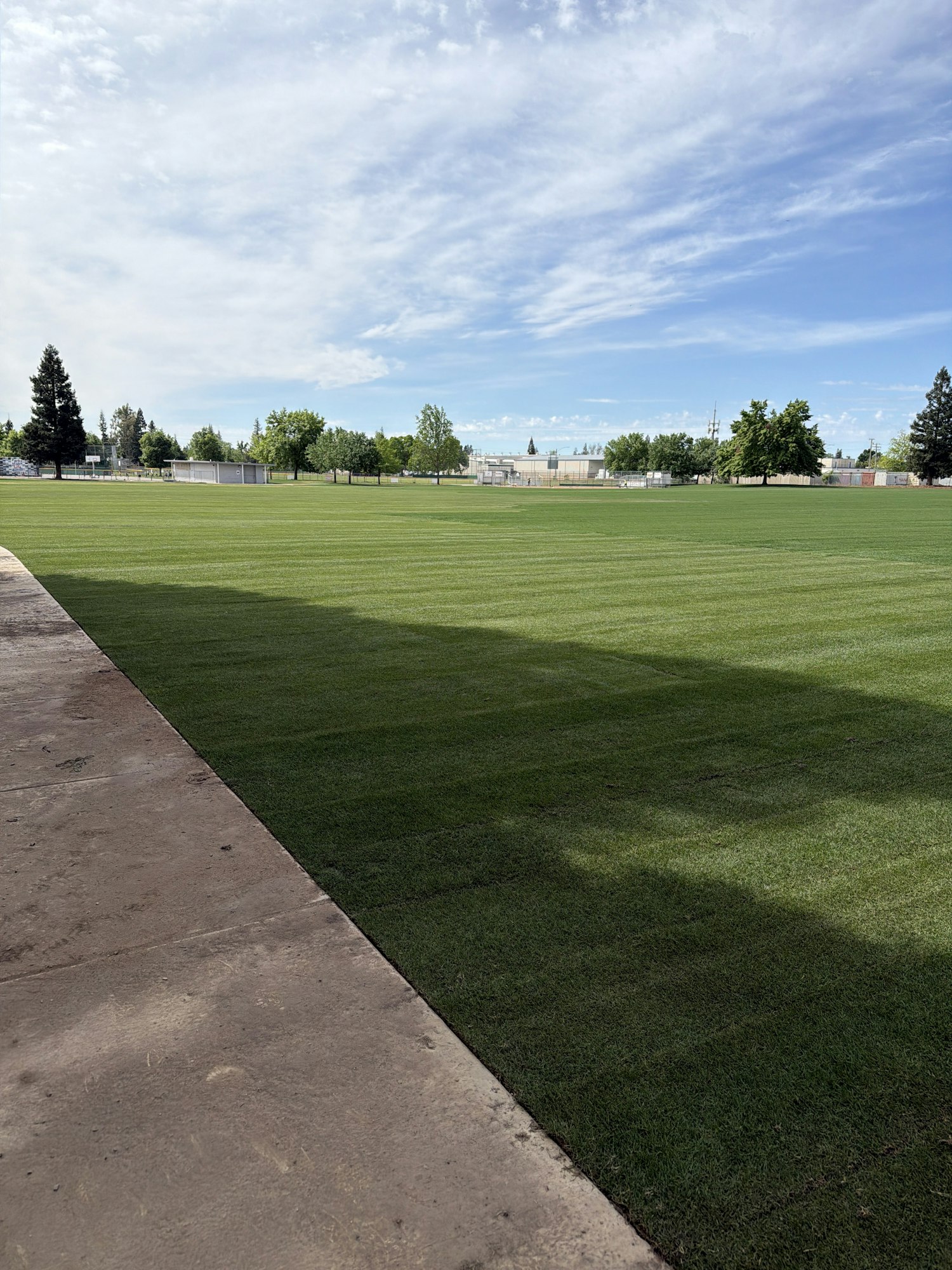

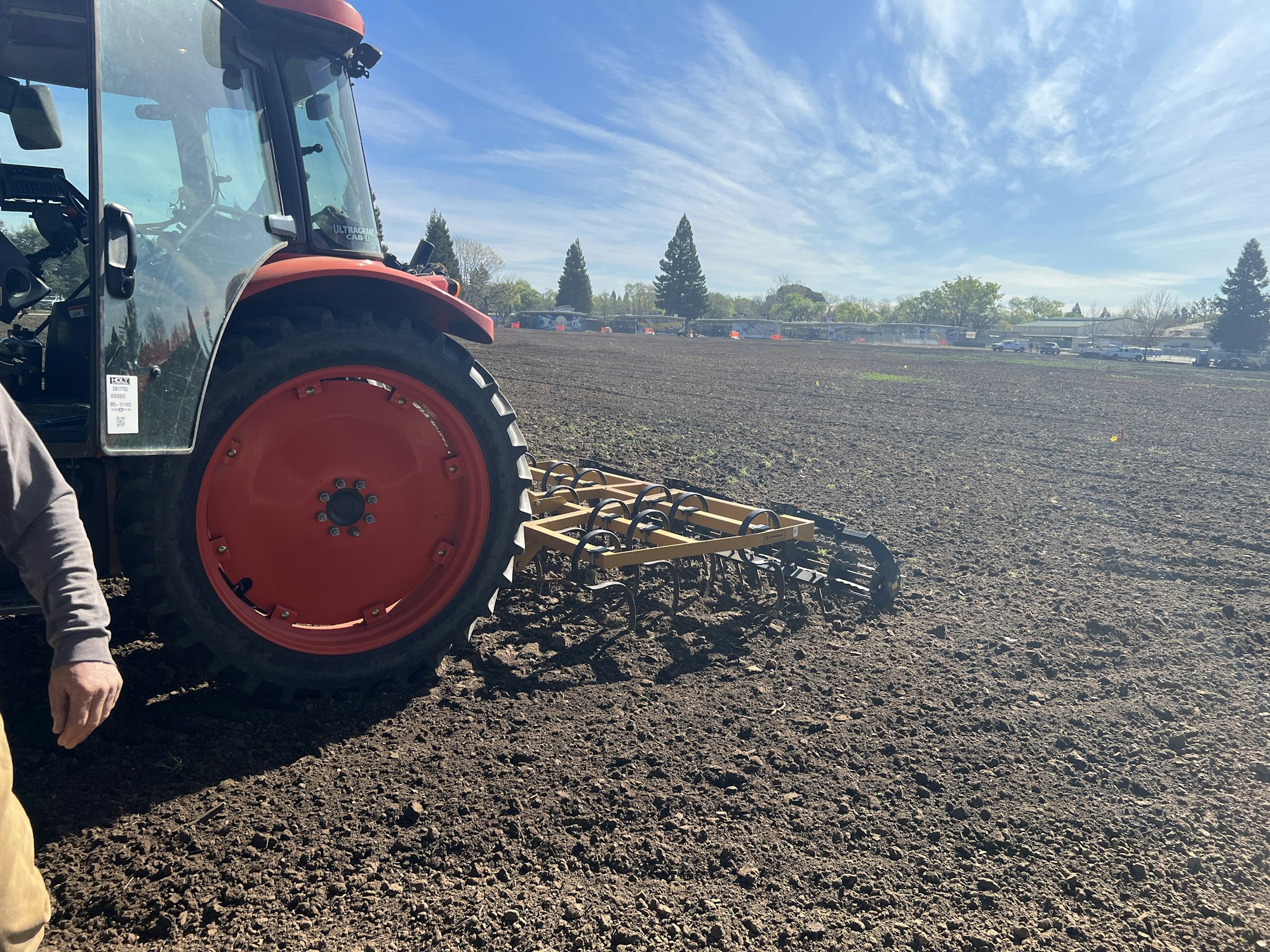

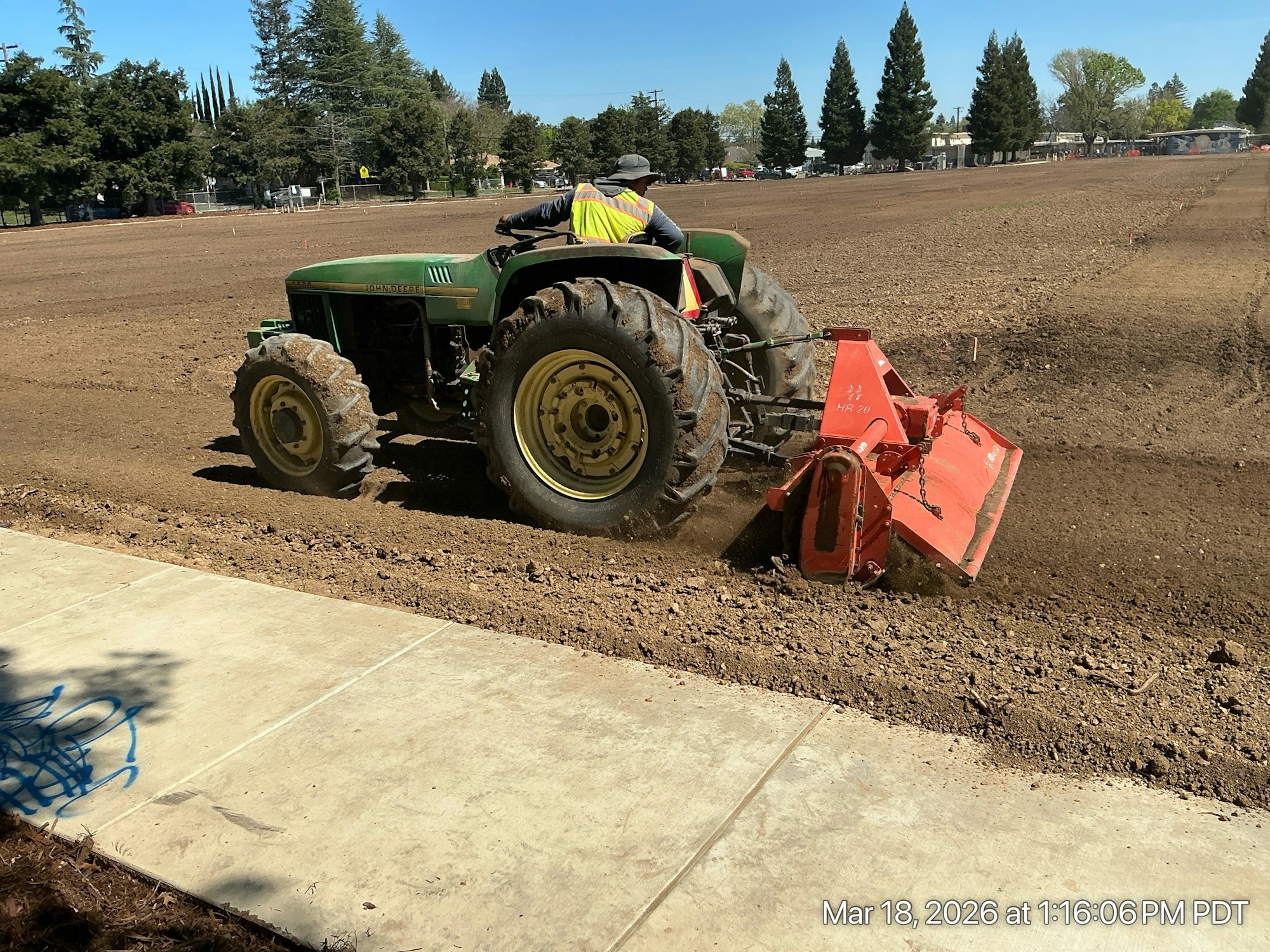

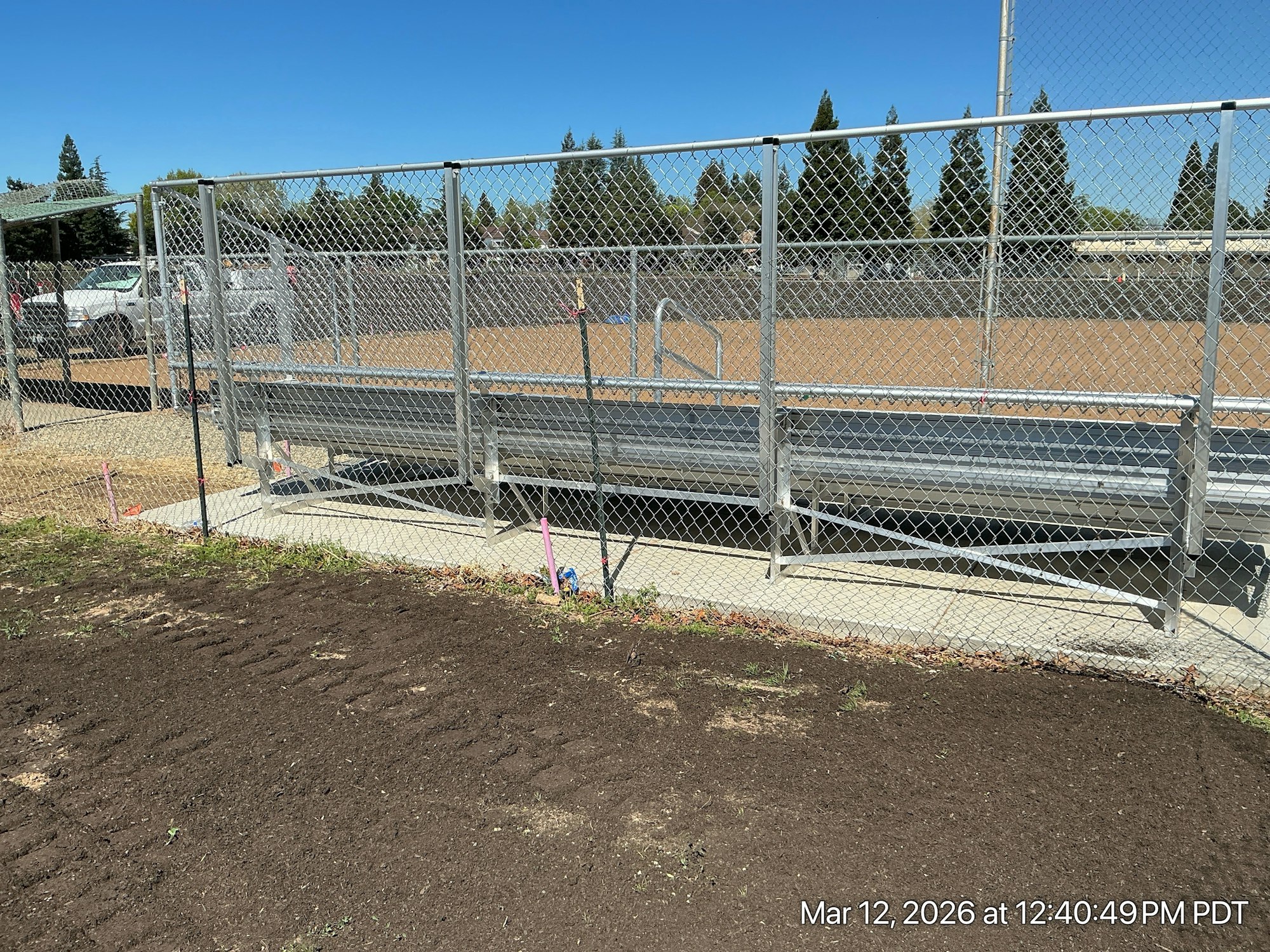

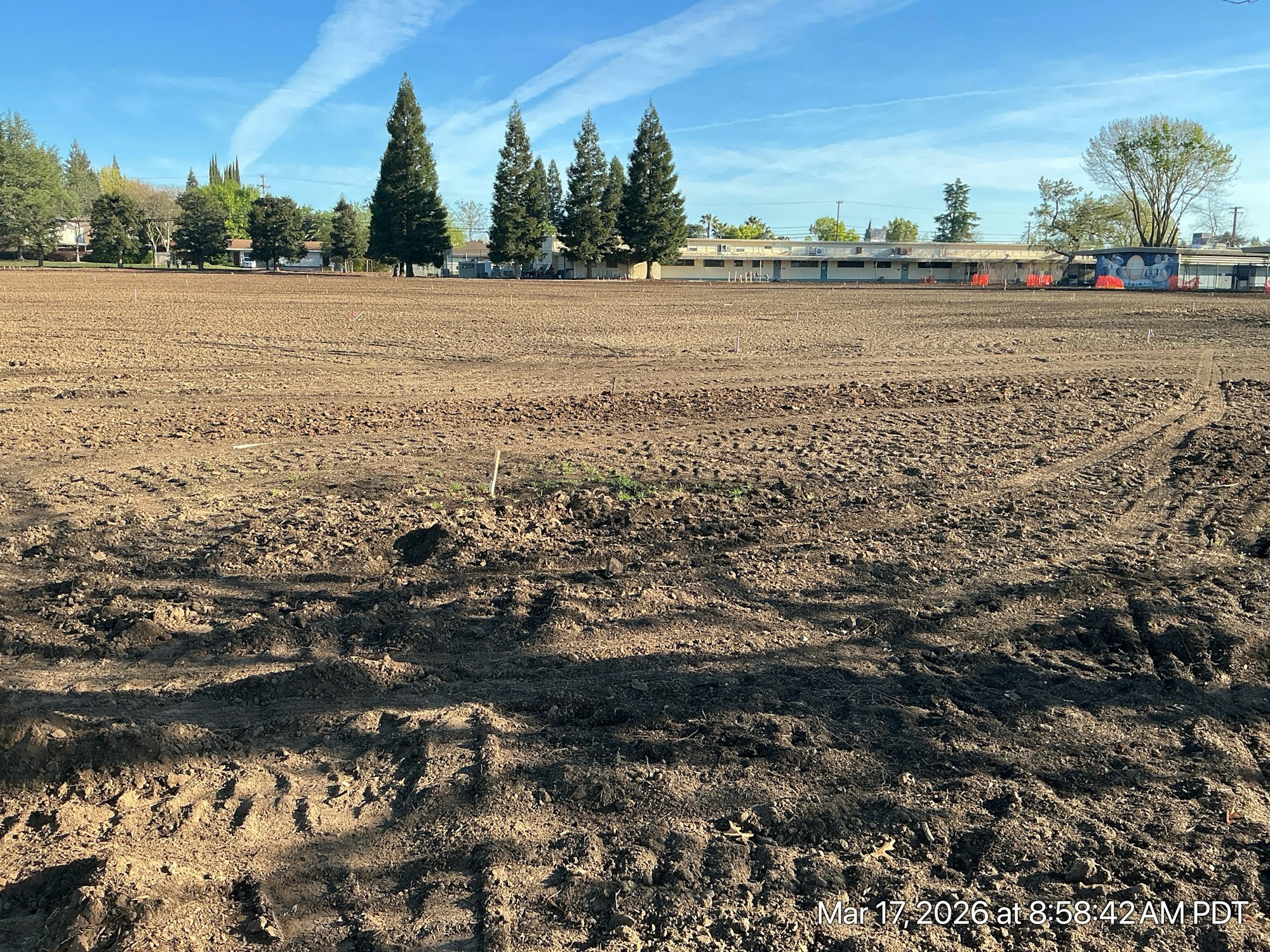

- August 2025 - Construction is underway on the field, with a focus on grading, drainage, and irrigation.
- August 1, 2025 - Groundbreaking Event
- June 2025 - Awarded and executed construction contract
- May 15, 2025 - Advisory Board Meeting - Action 1 - Accept the Lowest Responsible Bid from Olympic Land Construction for La Sierra Community Center Field Improvement Project, Action 2 - Approve Updated Total Project Budget and Accept the Lowest Responsible Bid from Trivel Construction for La Sierra Community Center HVAC Roofing Project
- October 17, 2024 - Project Design Presentation at the Advisory Board Meeting- Meeting Presentation
HVAC and Canopy Roofing Timeline:
- Current Progress (November 2025) - Installation of new HVAC on the John Smith Hall completed. Continued work on the second half of the HVAC replacement in the classroom wing. Canopy roofing is preparing for the installation of new gutters.

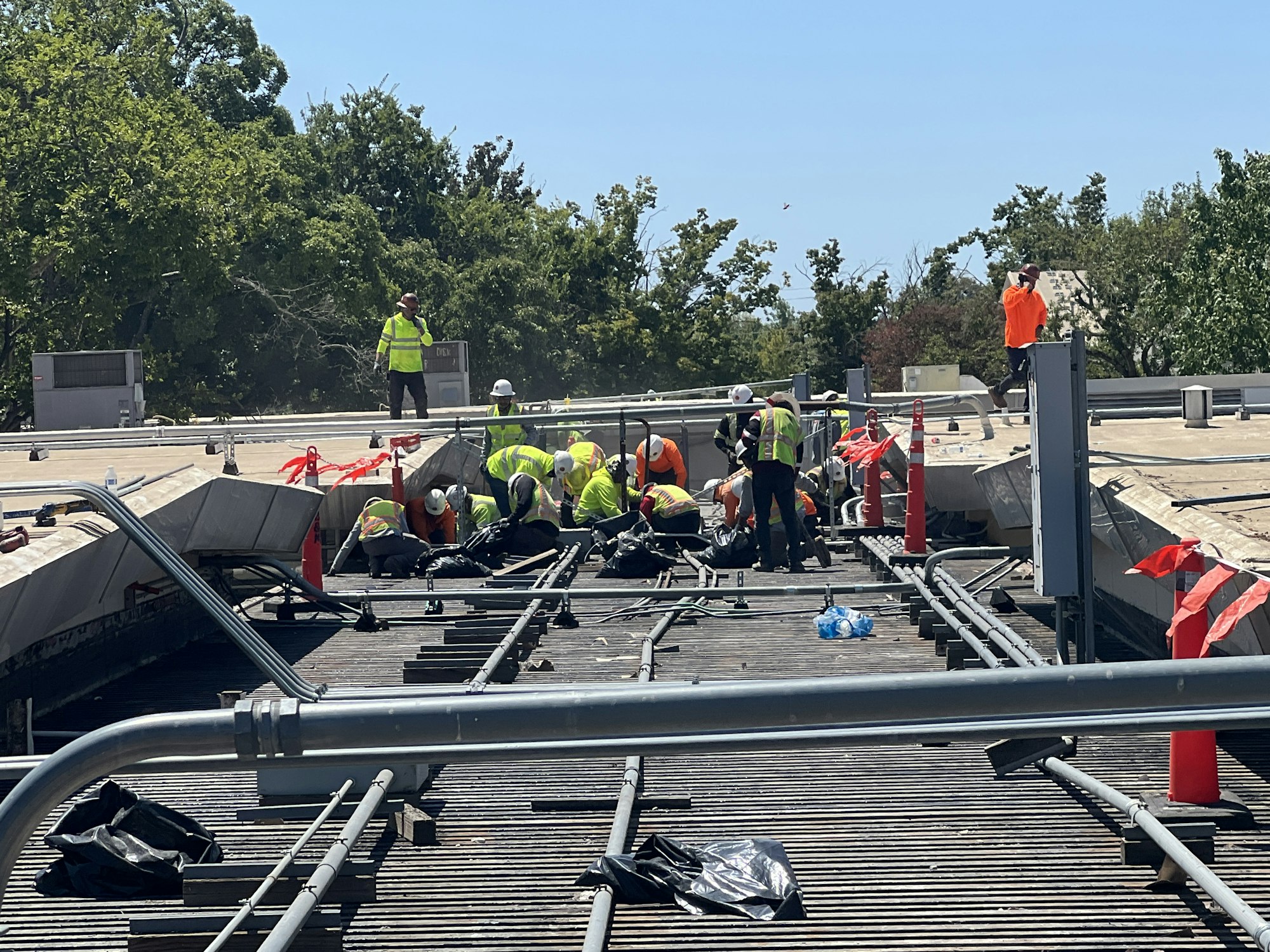

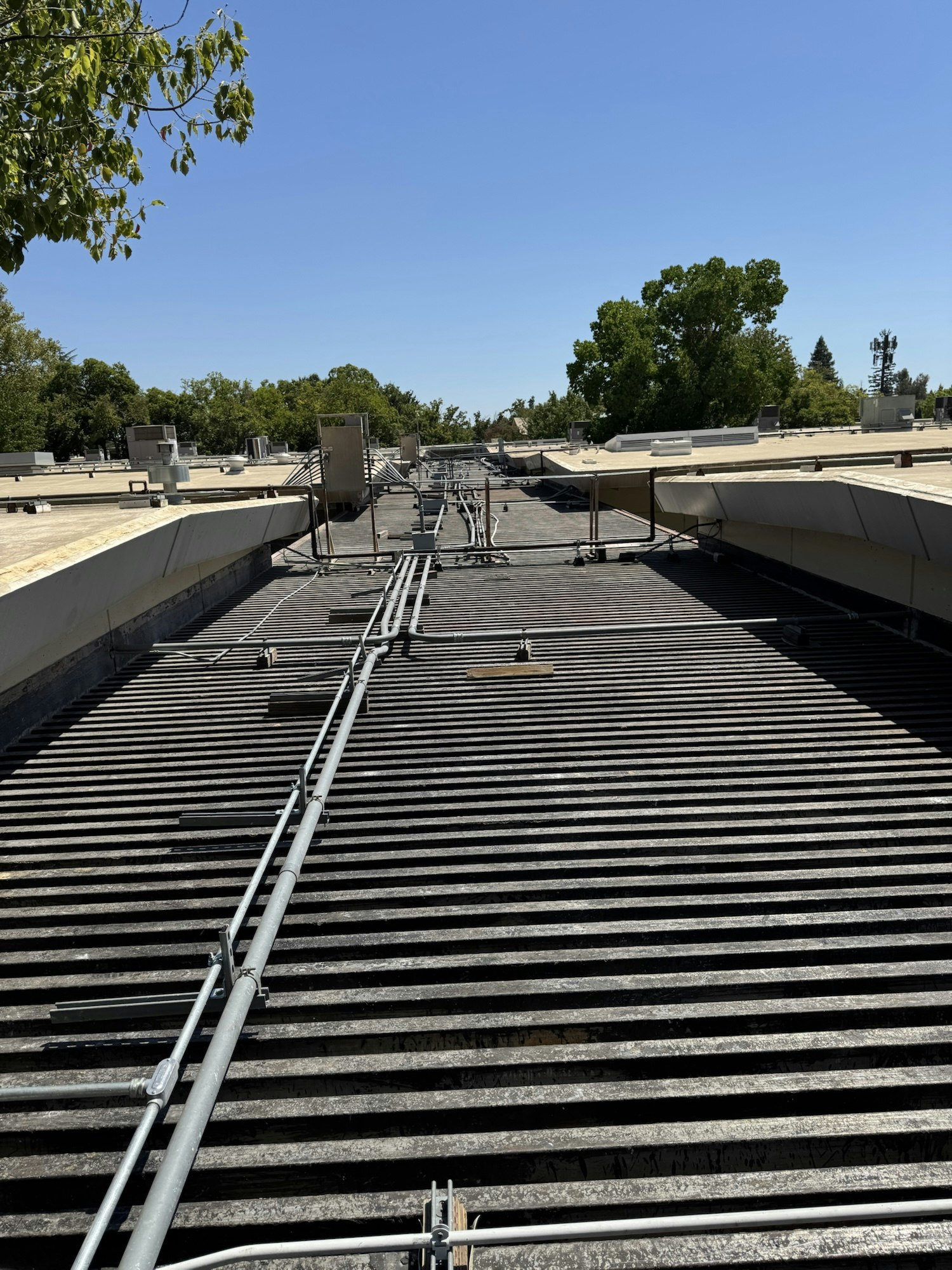

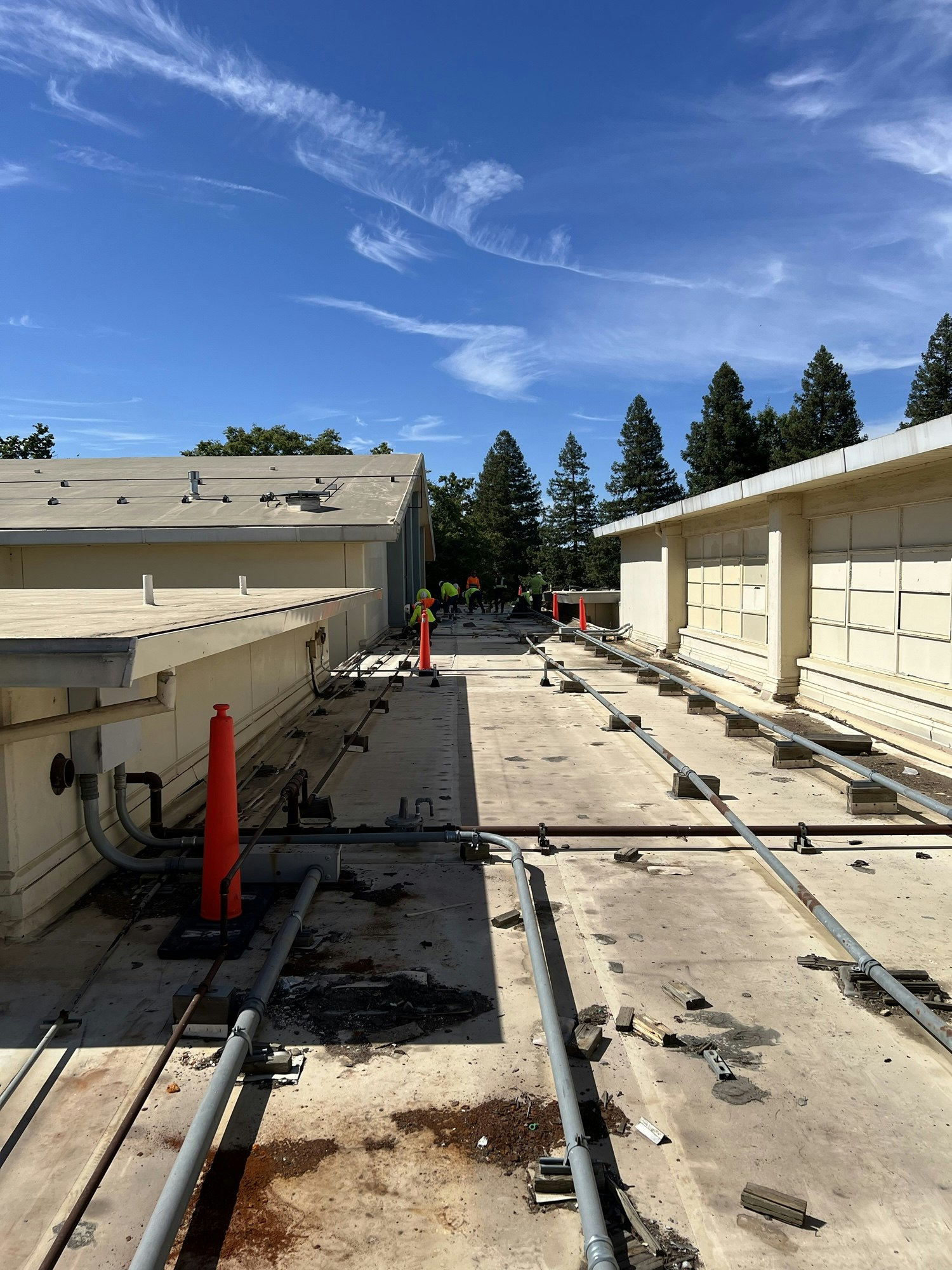

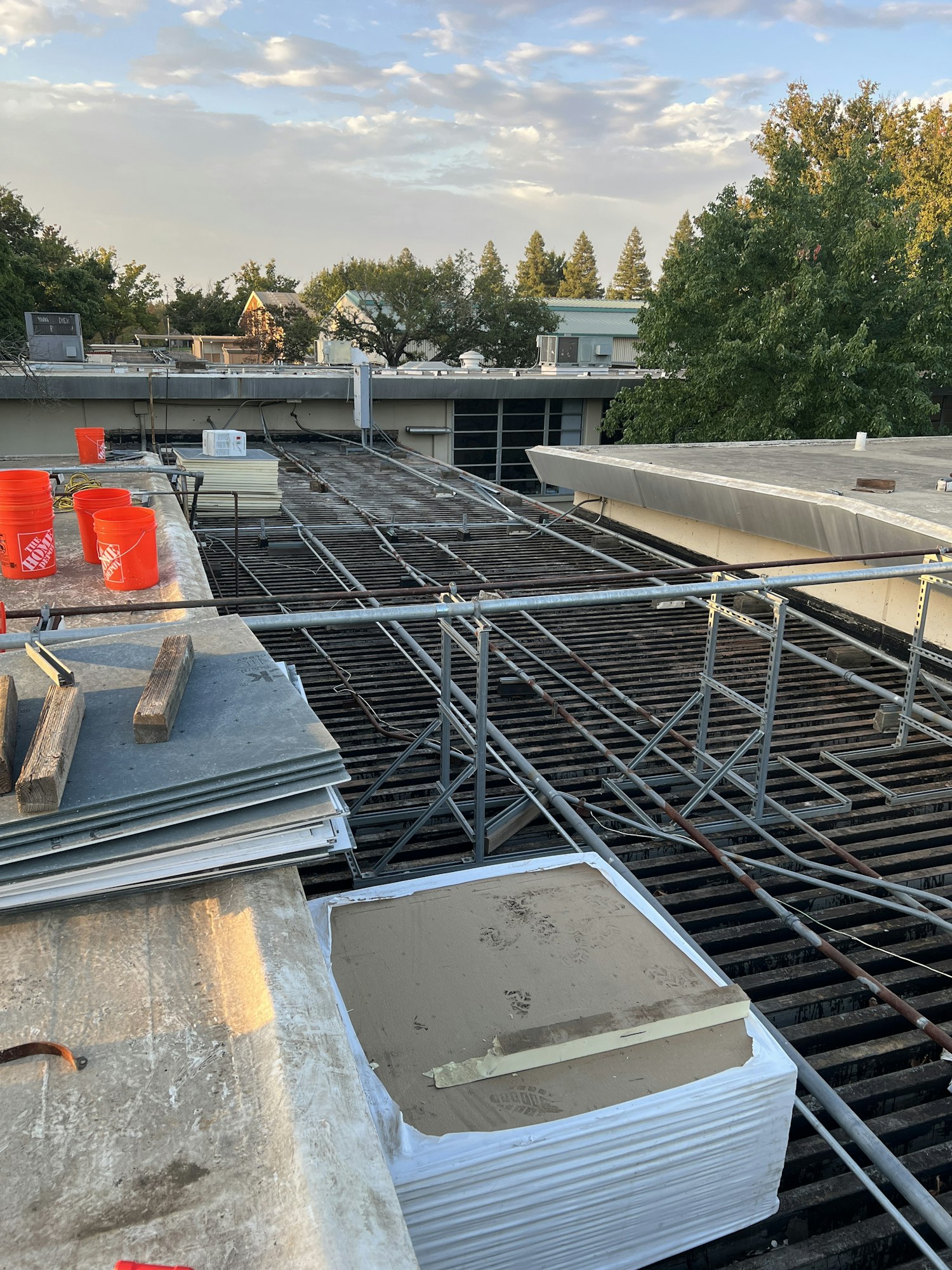

- October 2025 - Completion of the first half of HVAC installation is complete. The second half of the HVAC replacement is underway. New roofing material was installed on the canopy roofing.
- September 2025 - Preparation of indoor facilities and roof for new HVAC installation.

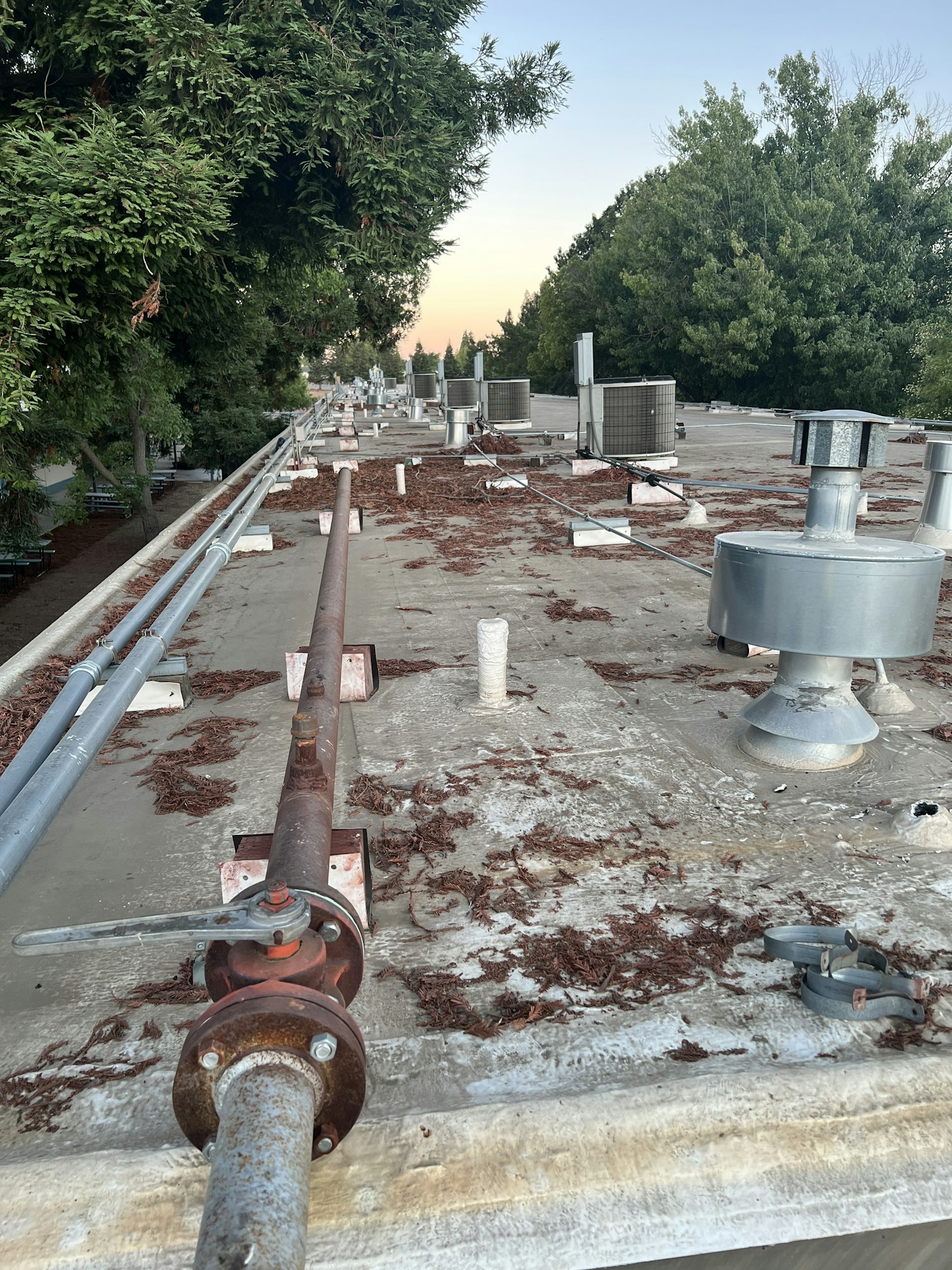

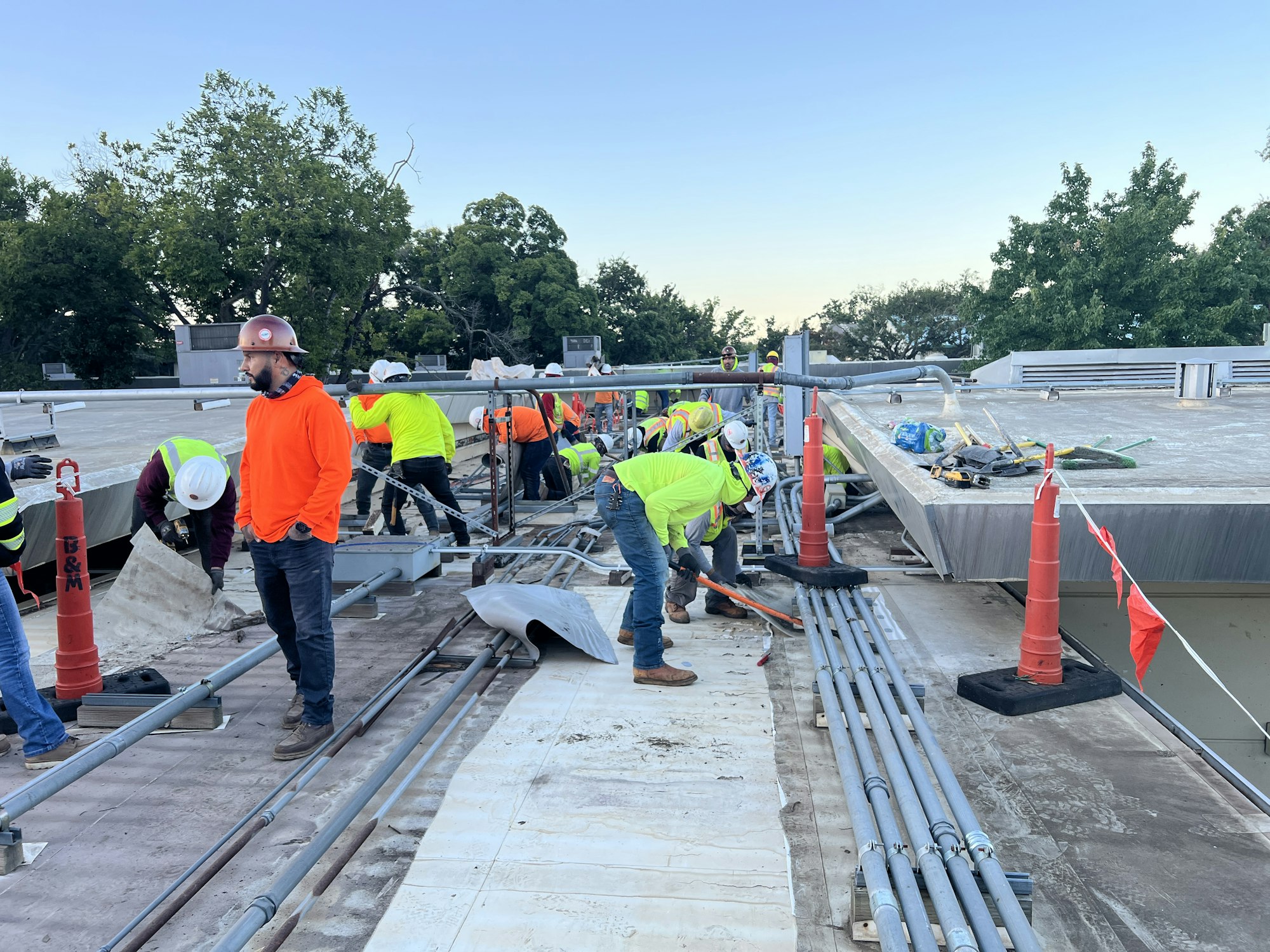

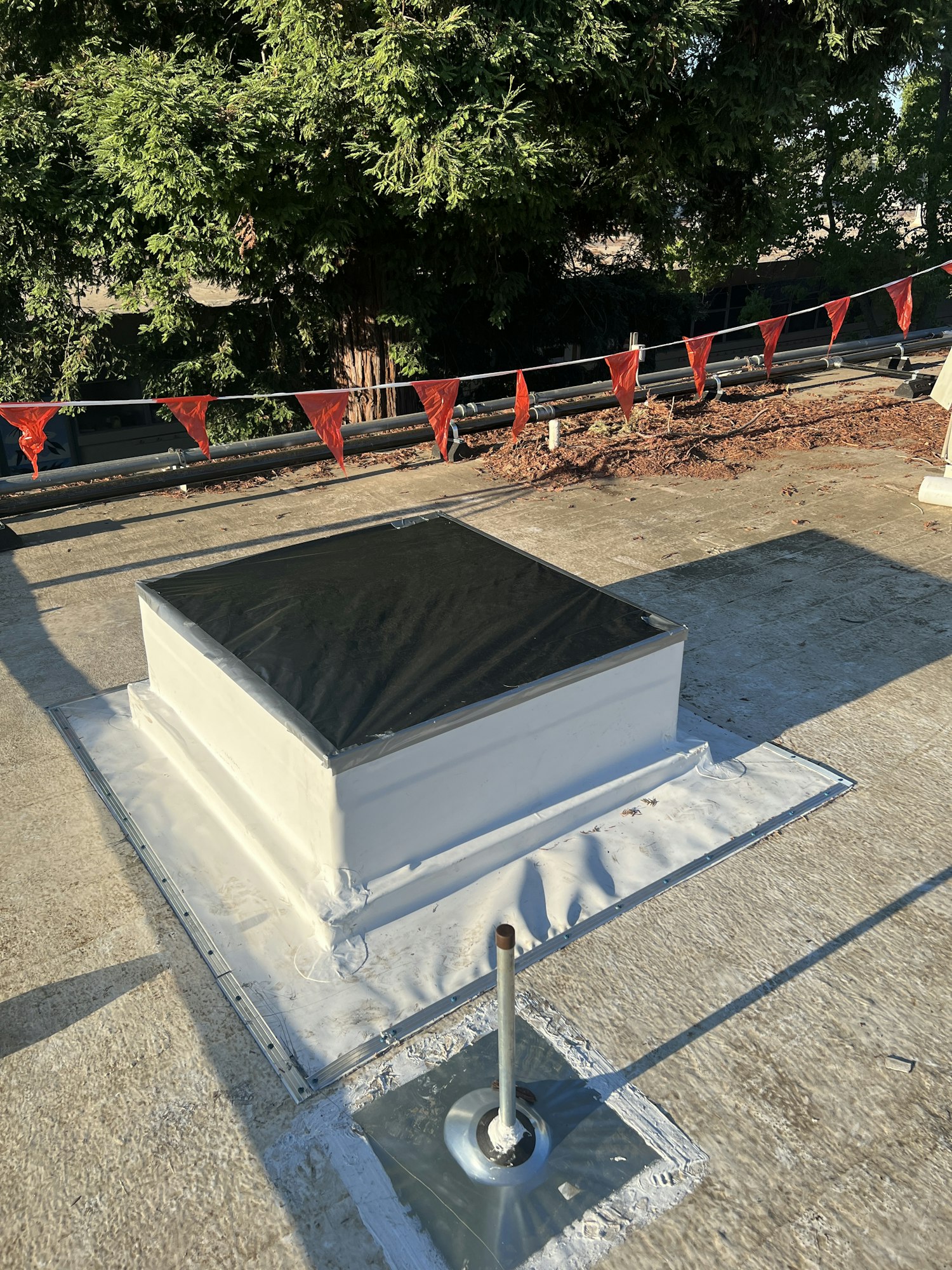

- August 2025 - Construction is underway. Canopy roofing completed demolition. Old HVAC units were removed from the facility. Roof repairs and new HVAC units preparation are underway.
- August 1, 2025 - Groundbreaking Event
- June 2025 - Awarded and executed construction contract
- May 15, 2025 - Advisory Board Meeting - Action 1 - Accept the Lowest Responsible Bid from Olympic Land Construction for La Sierra Community Center Field Improvement Project, Action 2 - Approve Updated Total Project Budget and Accept the Lowest Responsible Bid from Trivel Construction for La Sierra Community Center HVAC Roofing Project
- October 17, 2024 - Project Design Presentation at the Advisory Board Meeting- Meeting Presentation
Field Project Pictures

Measure G projects

Map of field and canopy project areas

Field plan

Field Project Area

Field Project Area

Field Project Area

Field Project Area

Field Project Area

Field Project Area

Field Project Area

Field Project Area

Canopy Roofing and HVAC Project Pictures

Canopy replacement and repair map
